Build updates

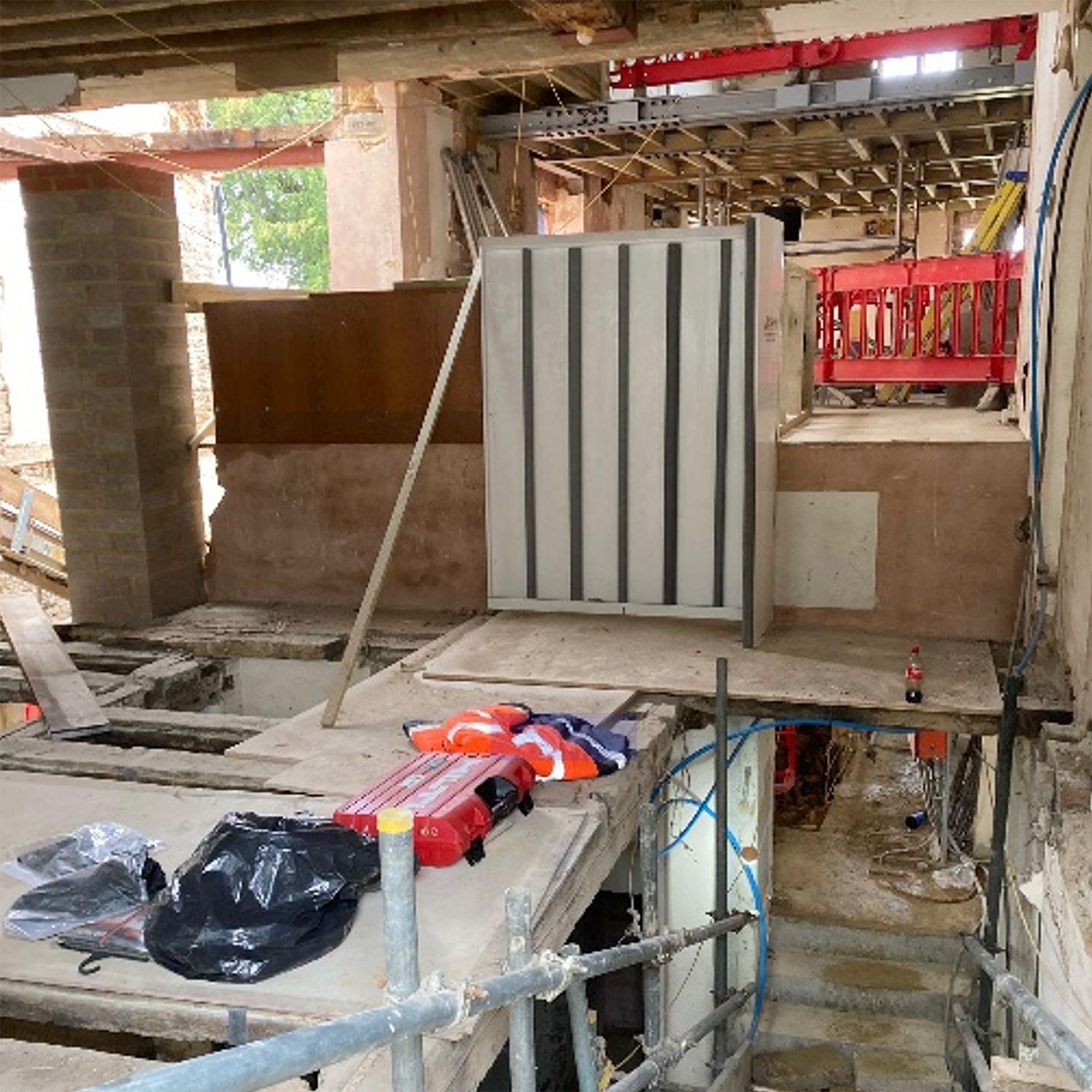

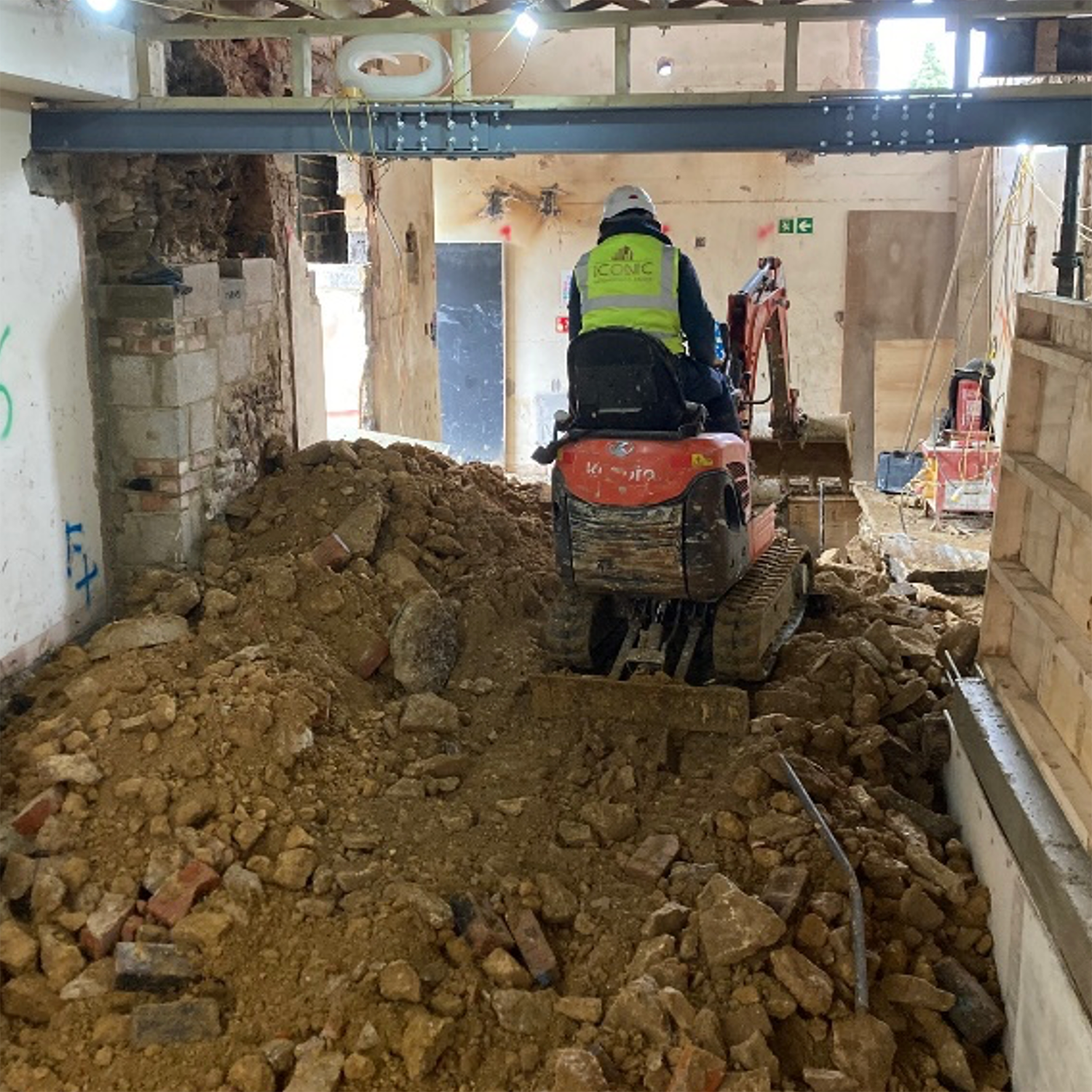

March

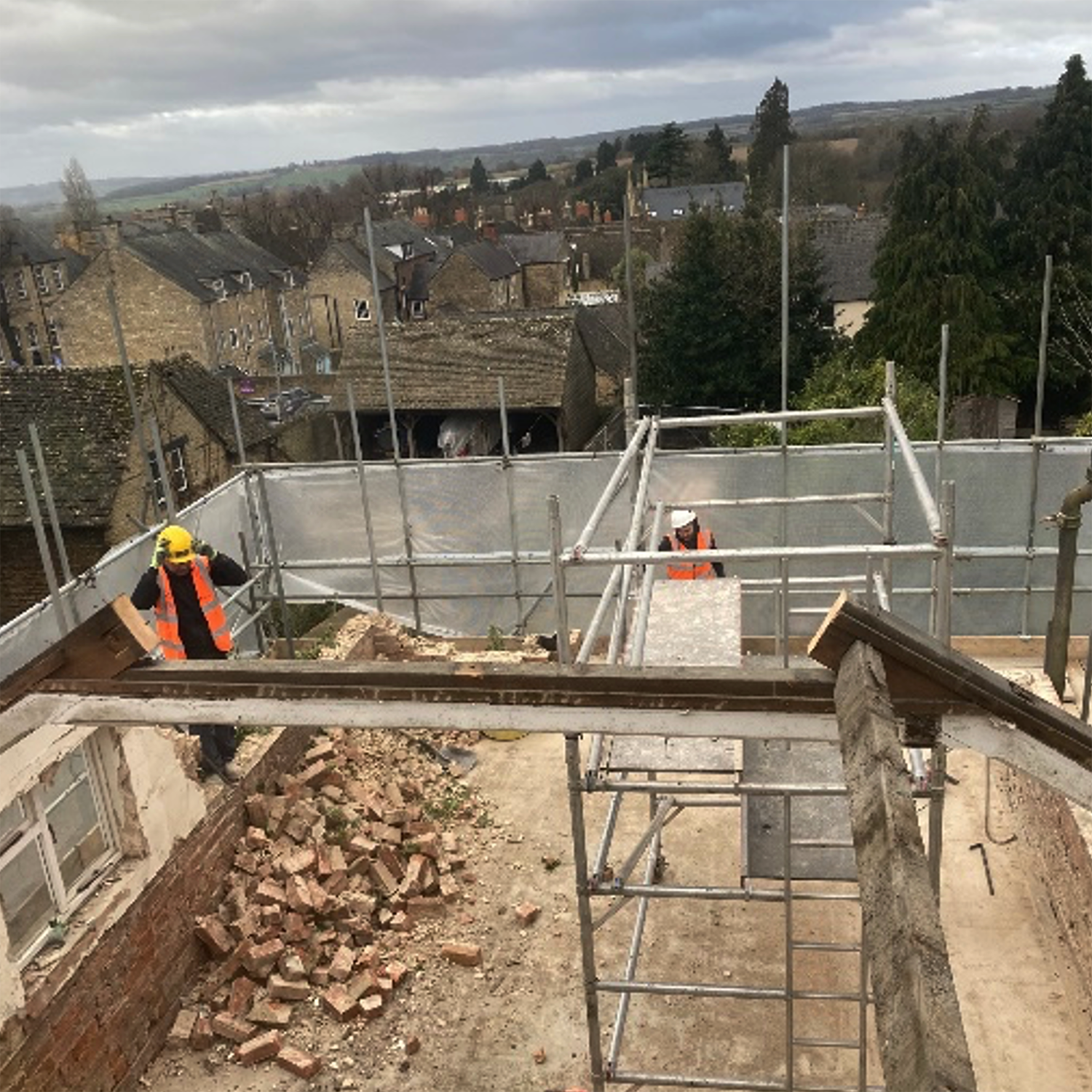

- Completed external tiling of Community Hall

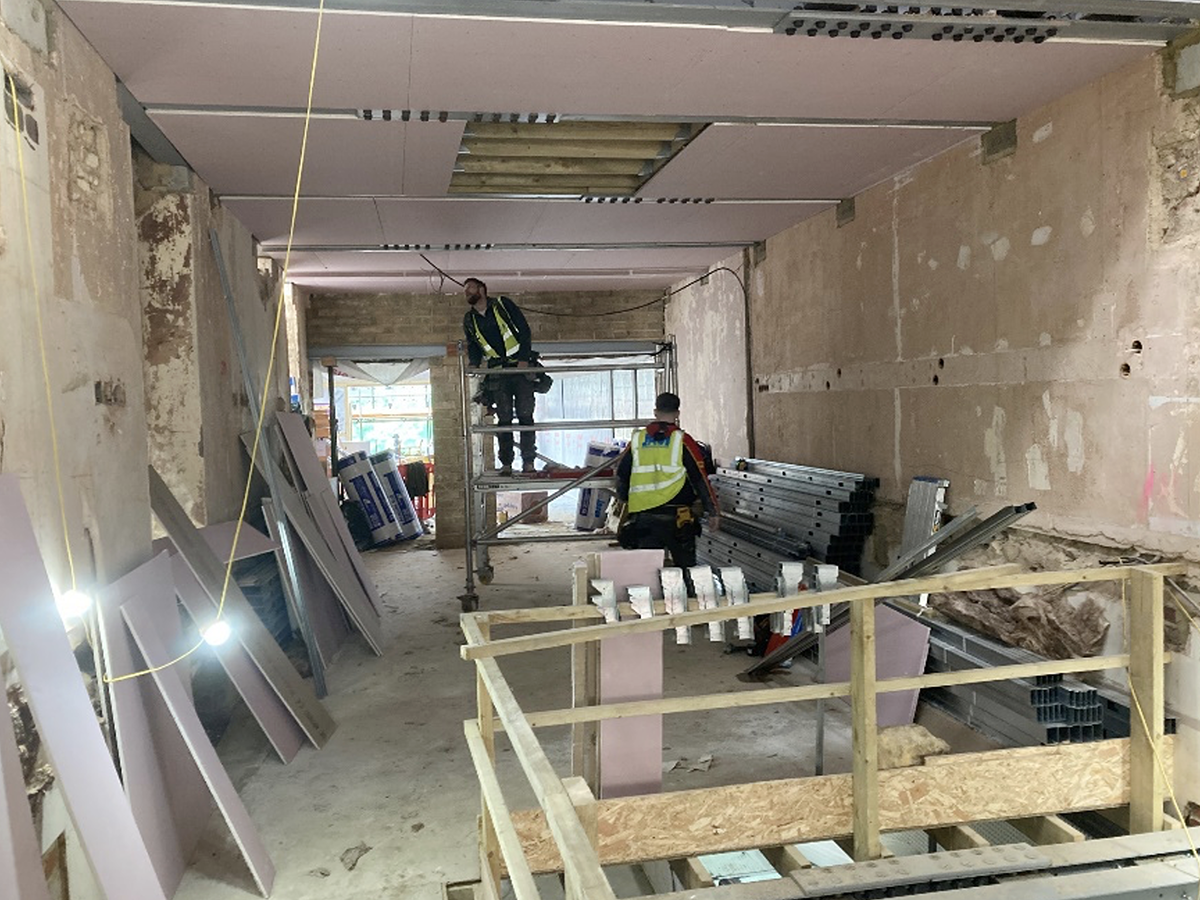

- Completed partitions & plaster-boarding
- Completed ‘first fix’ (mechanical & electrical)
- Installed lift (Basement to First Floor)
- Completed T&G cladding in Hall

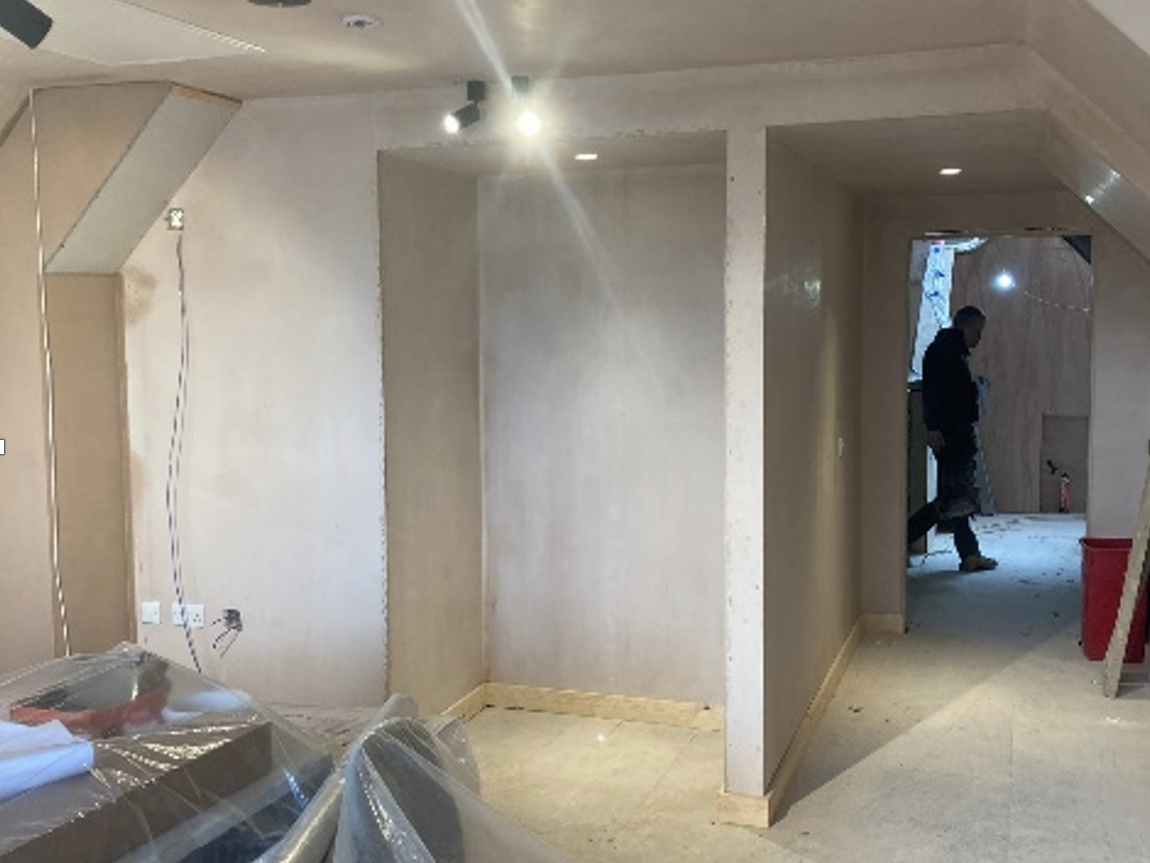

- Commenced decorating

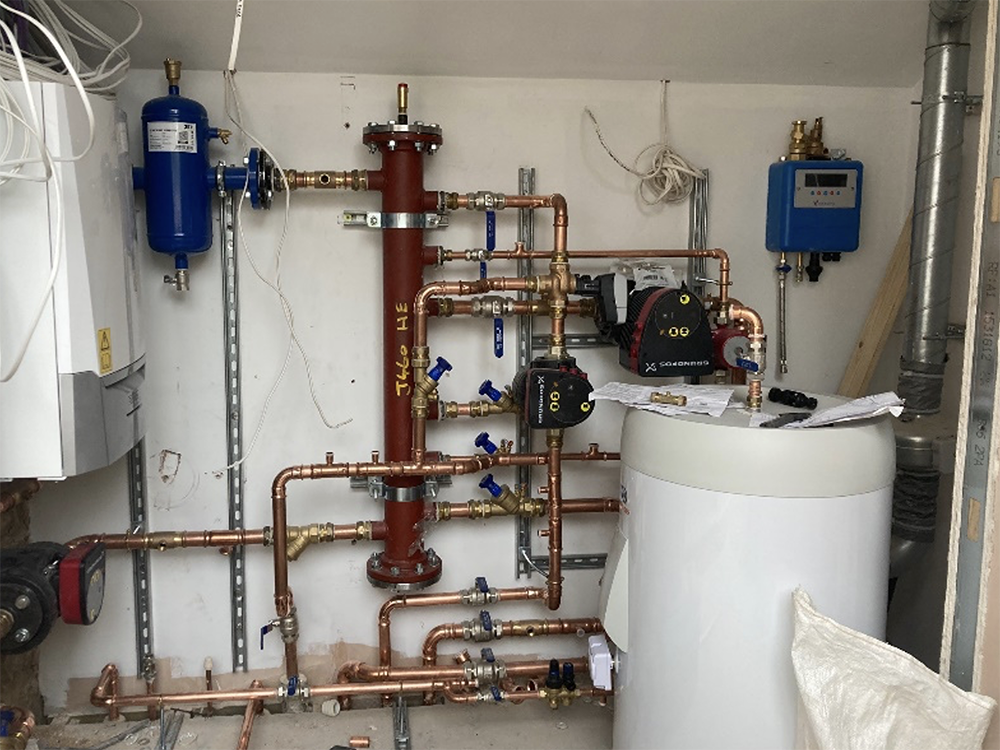

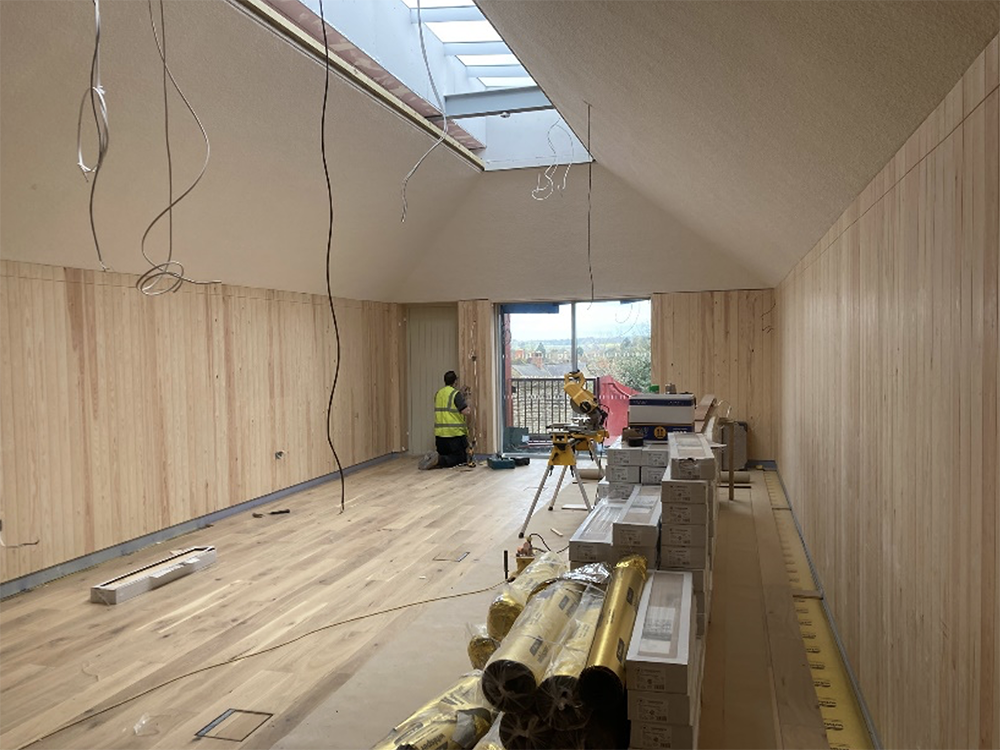

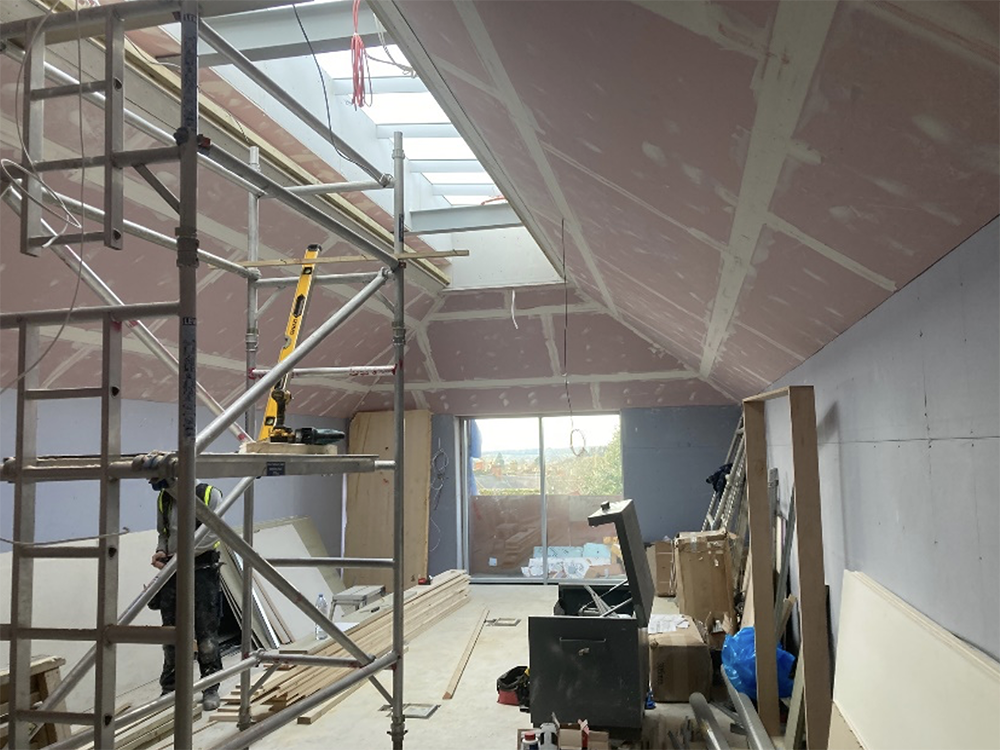

- Commenced installing flooring finishes
- Commenced installing joinery items





February

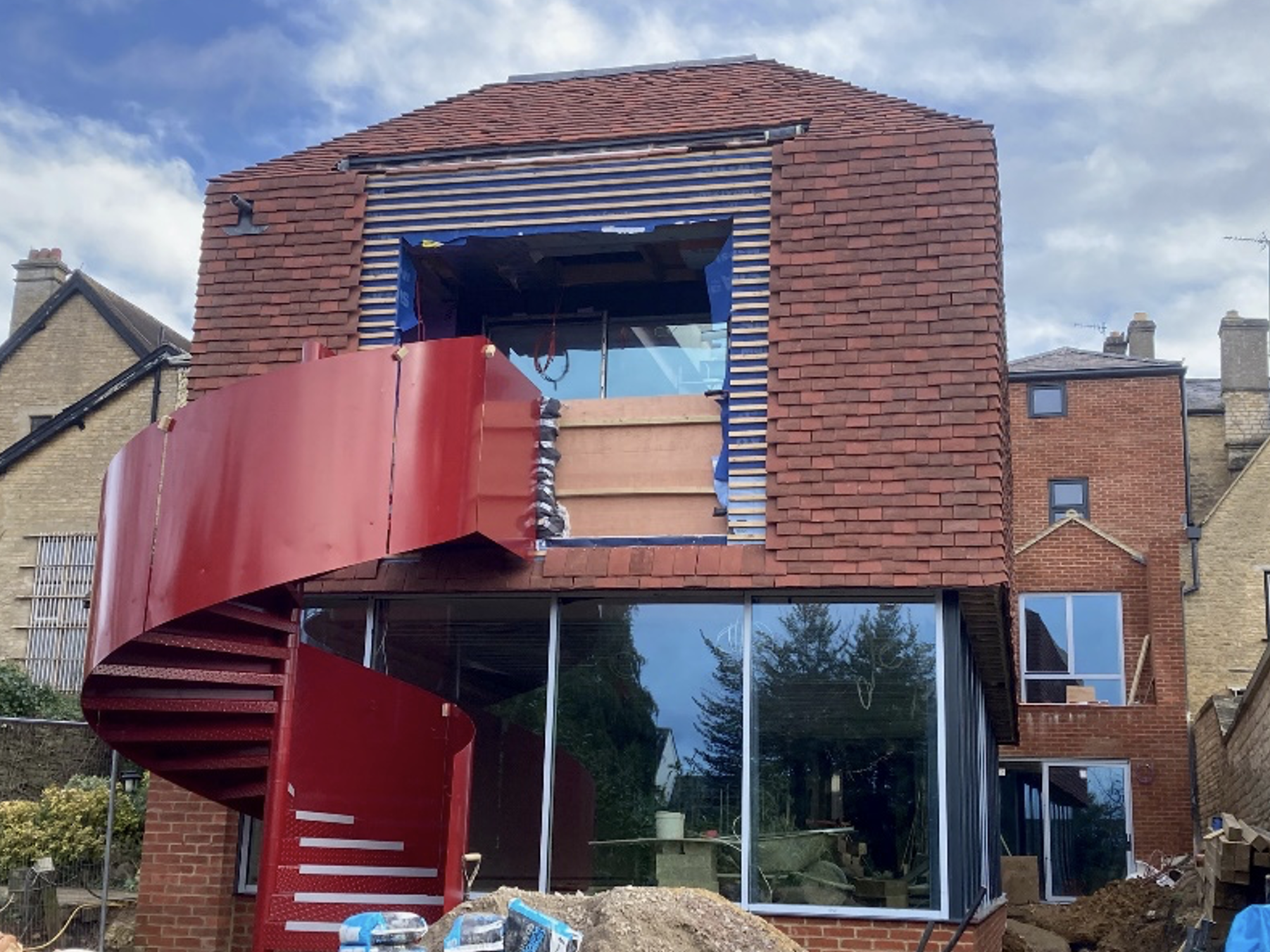

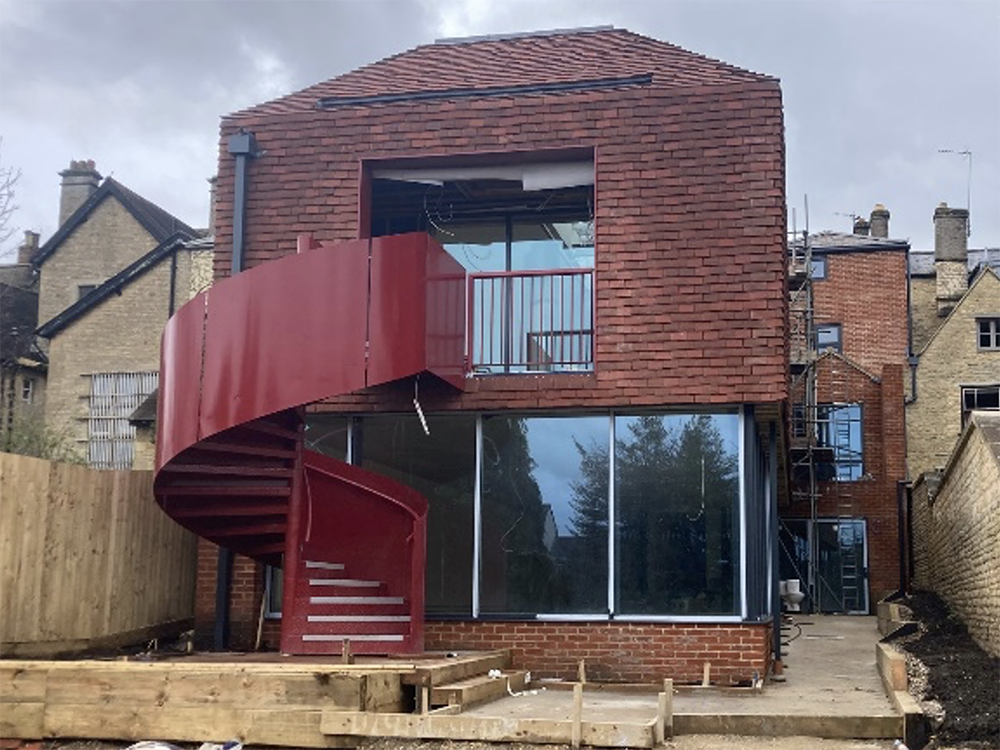

- Installed external spiral stairs (Community Hall to garden)

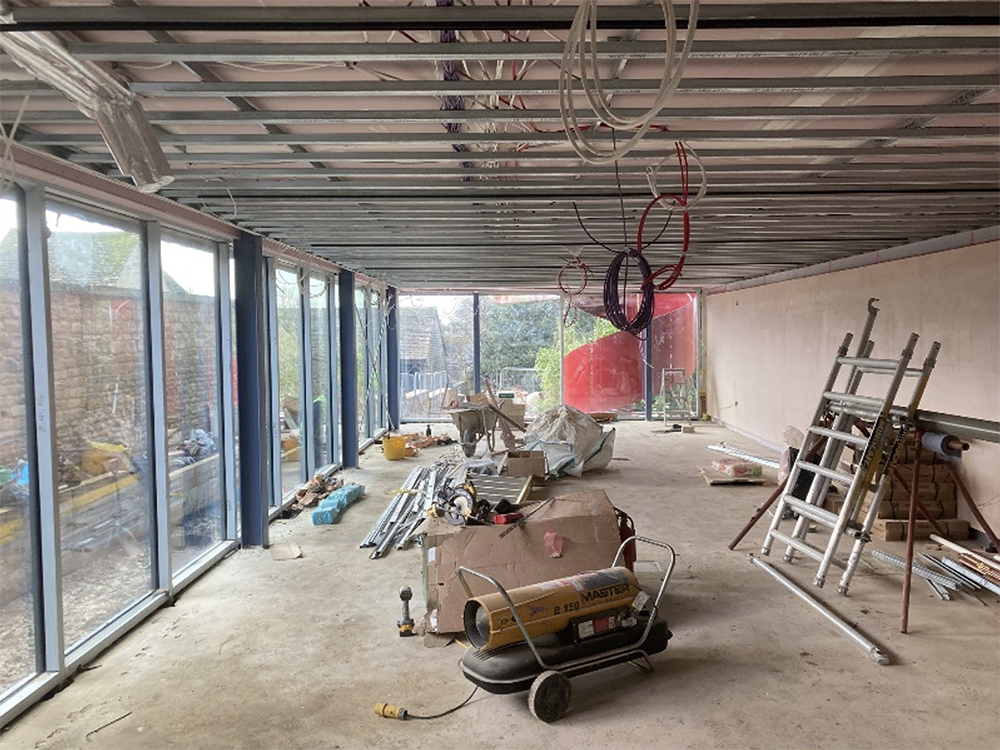

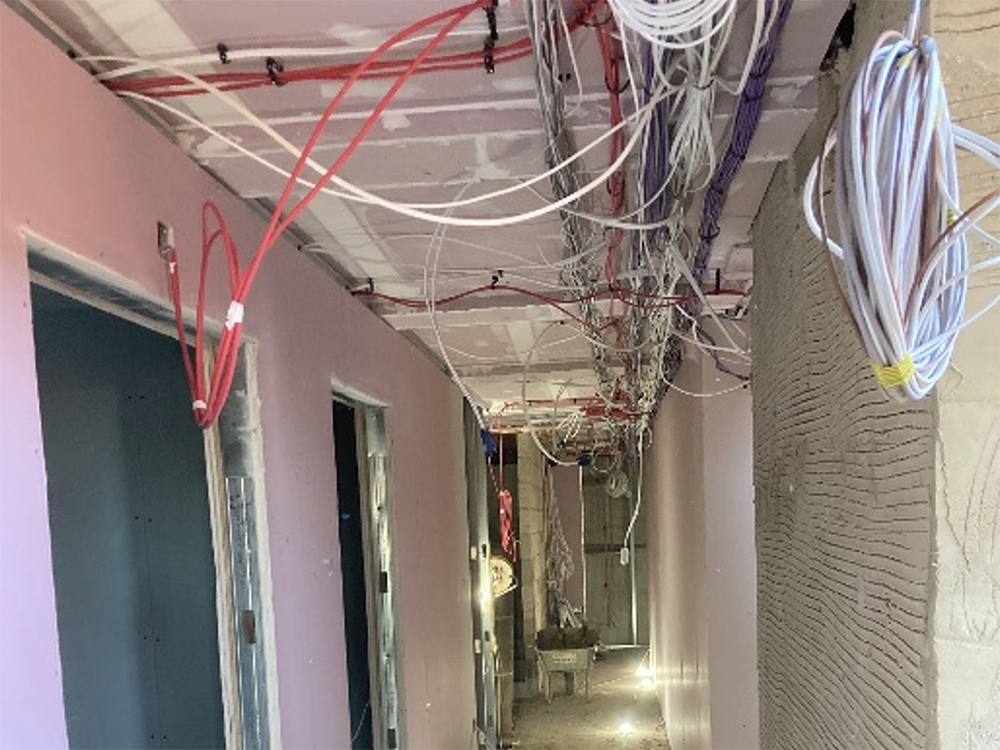

- Continued fitting-out phase & ‘first fix’ (mechanical, electrical & plumbing)

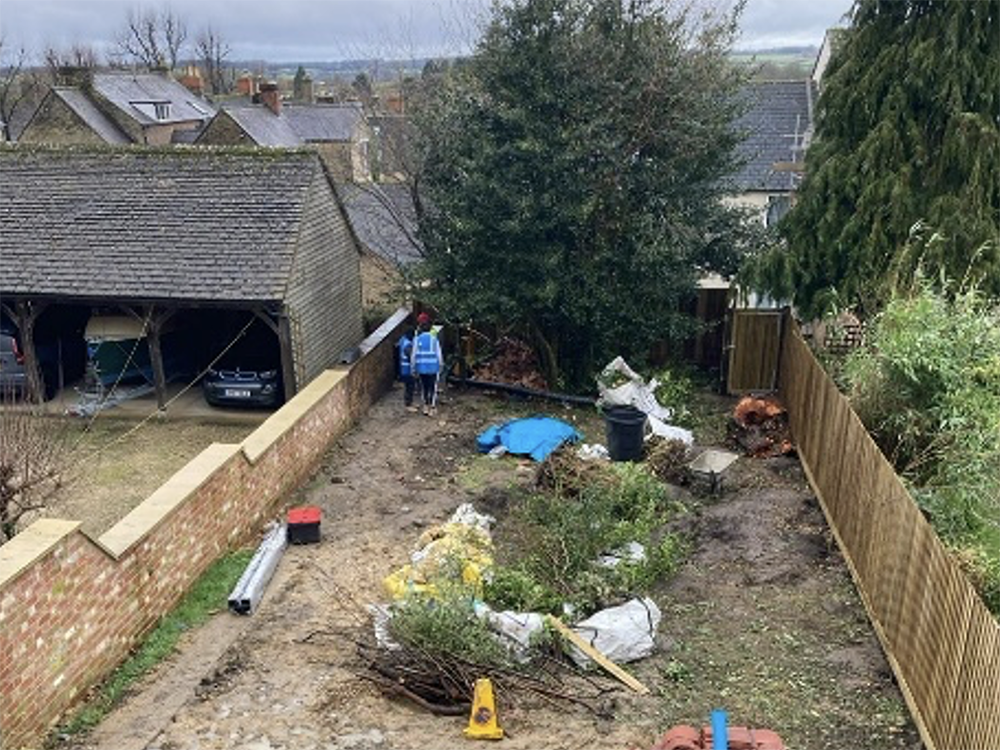

- Completed garden ground-works
- Installed air-source heat pump in garden
- Volunteers cleared garden of bamboo etc.
- Erected garden fences & rear gate





January

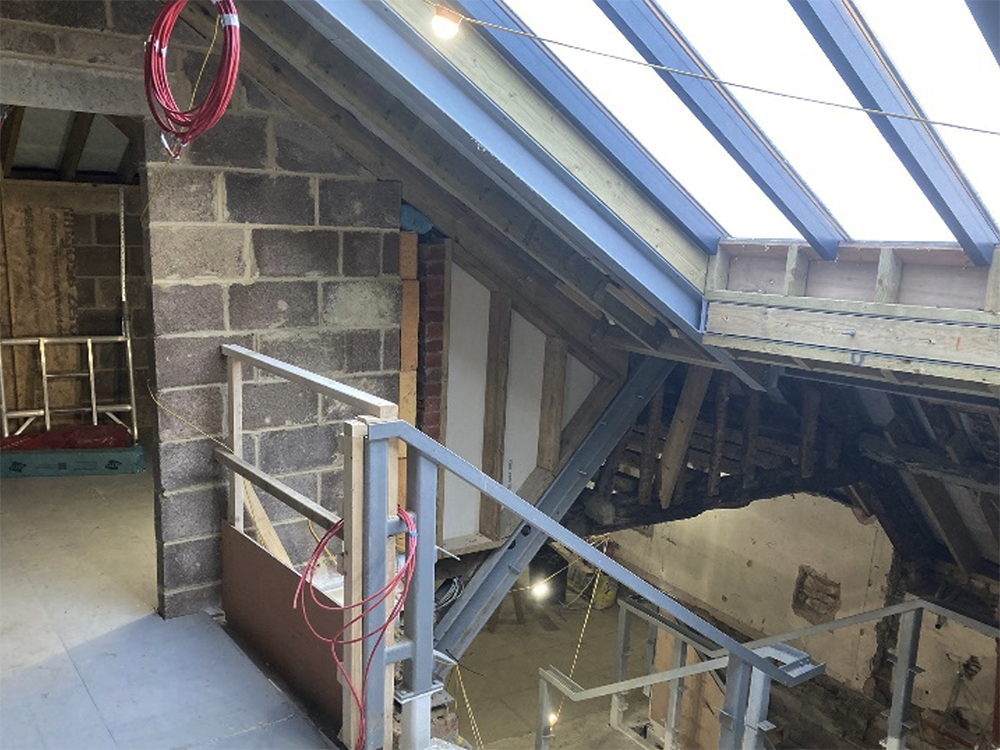

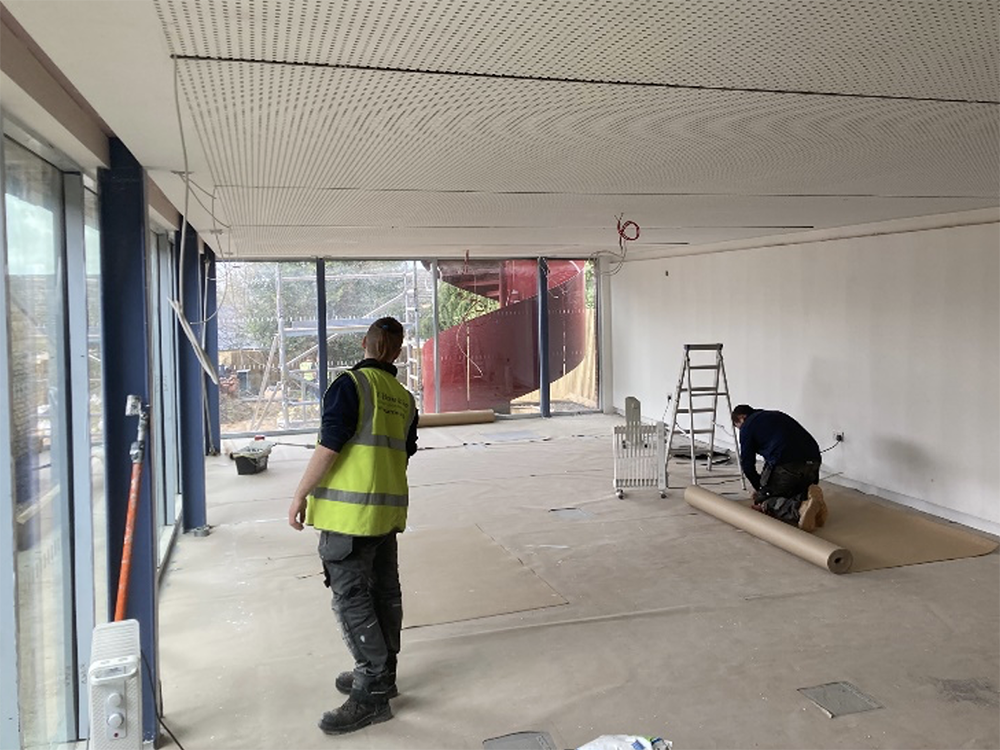

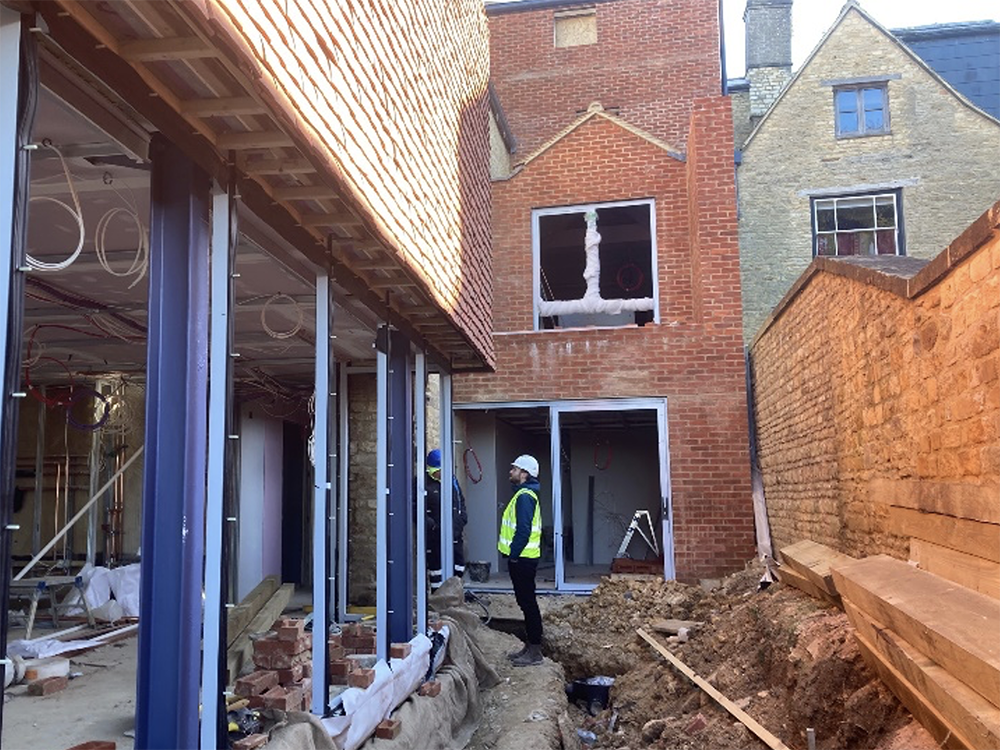

- Completed installation of glazed ‘curtain walling’ to Community Hall (garden level)
- Removal of hoarding & compound at front
- Completed screeding in Basement area

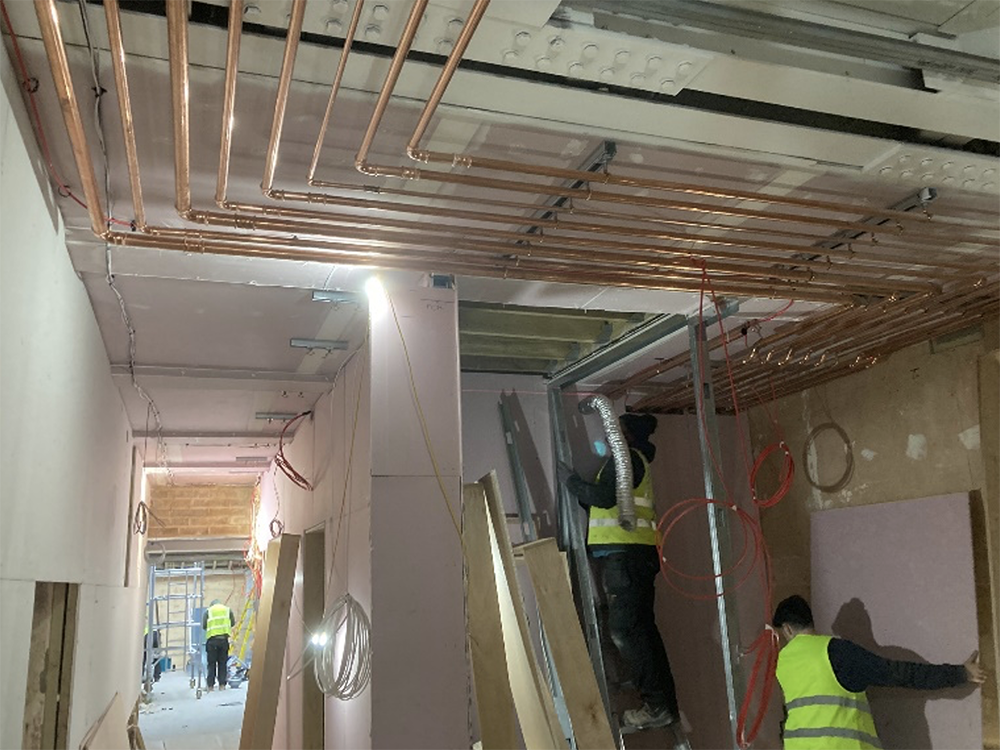

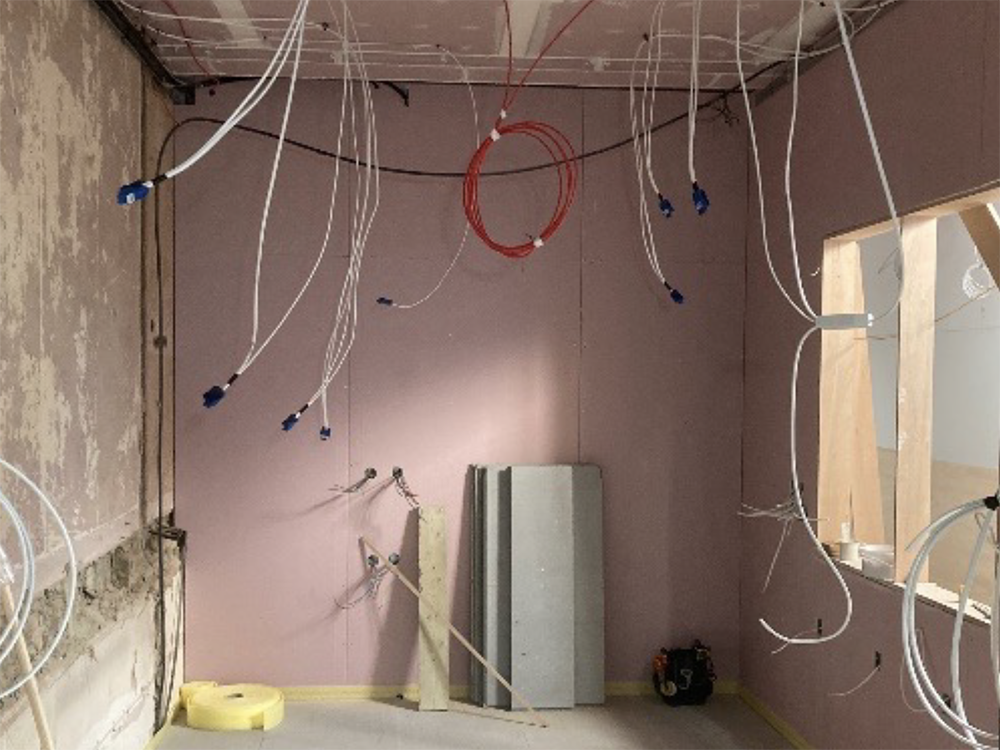

- Continued fitting-out phase & ‘first fix’ (mechanical, electrical & plumbing)
- Installed or repaired all external windows
- Floor build-up preparation on Ground Floor





December

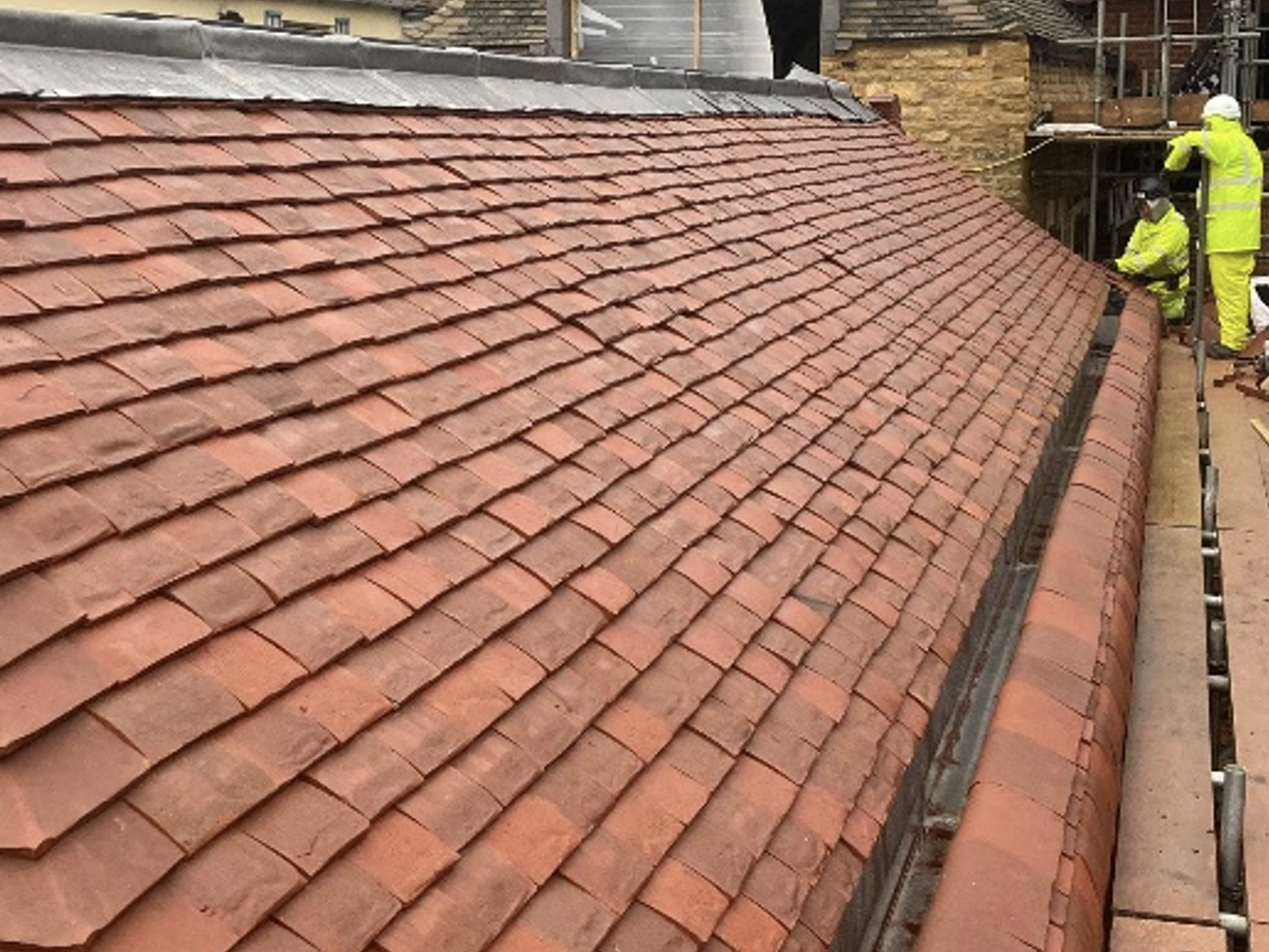

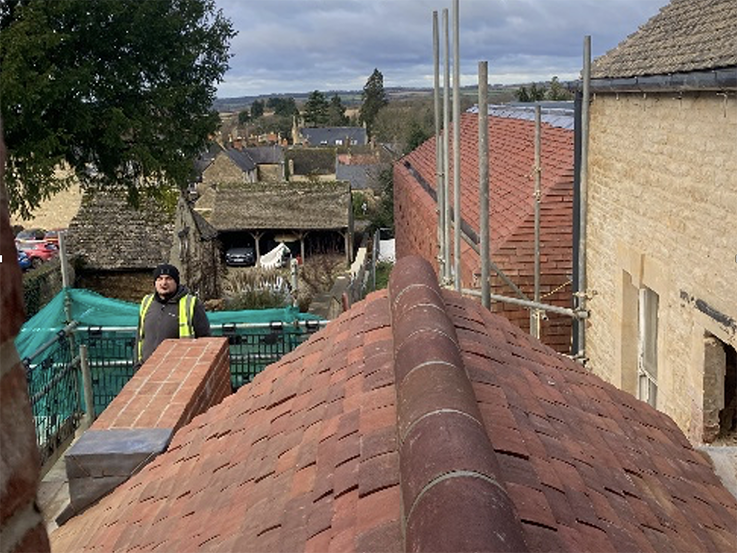

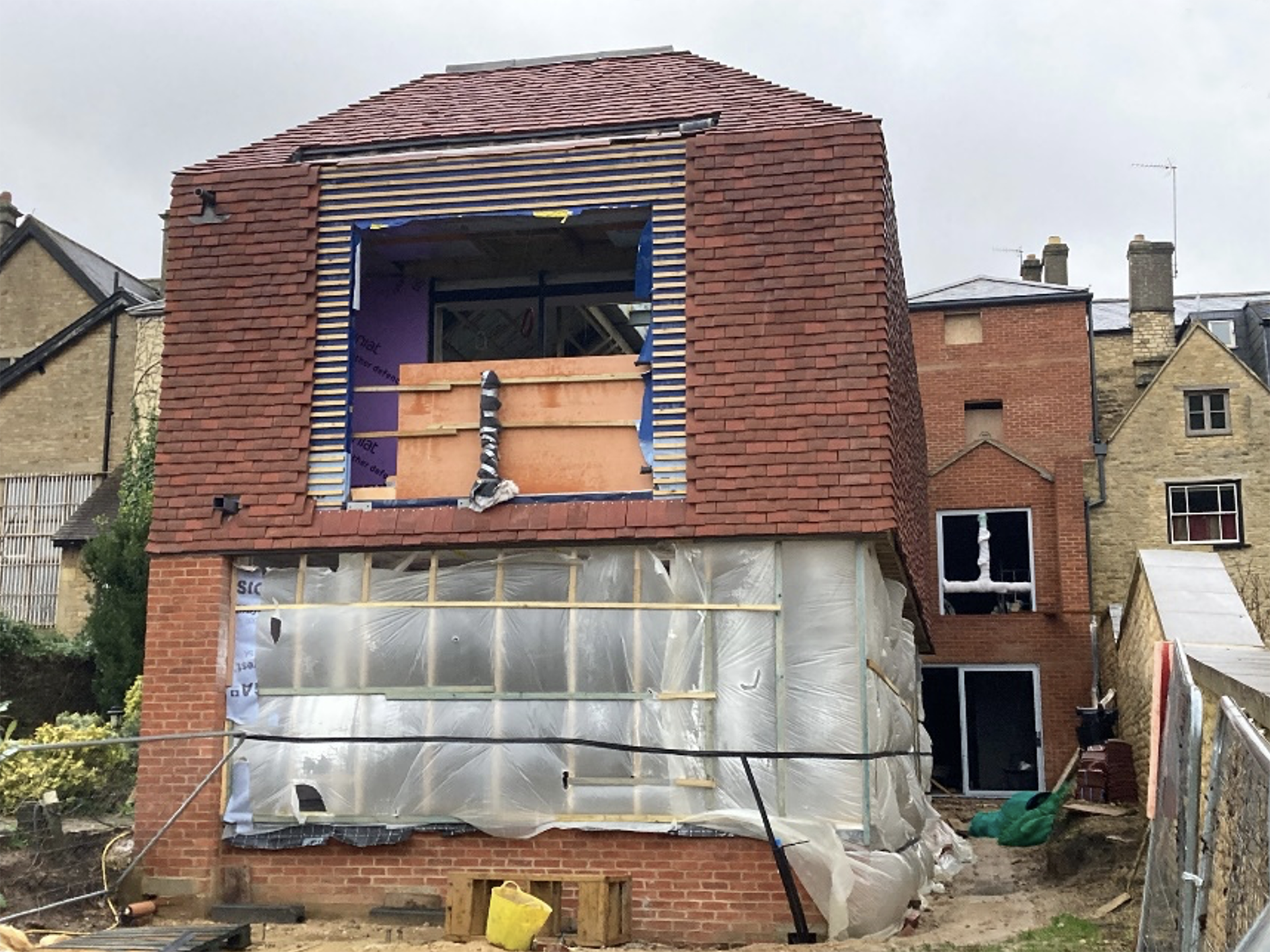

- Completed all roofing & leading works throughout – building now ‘watertight’

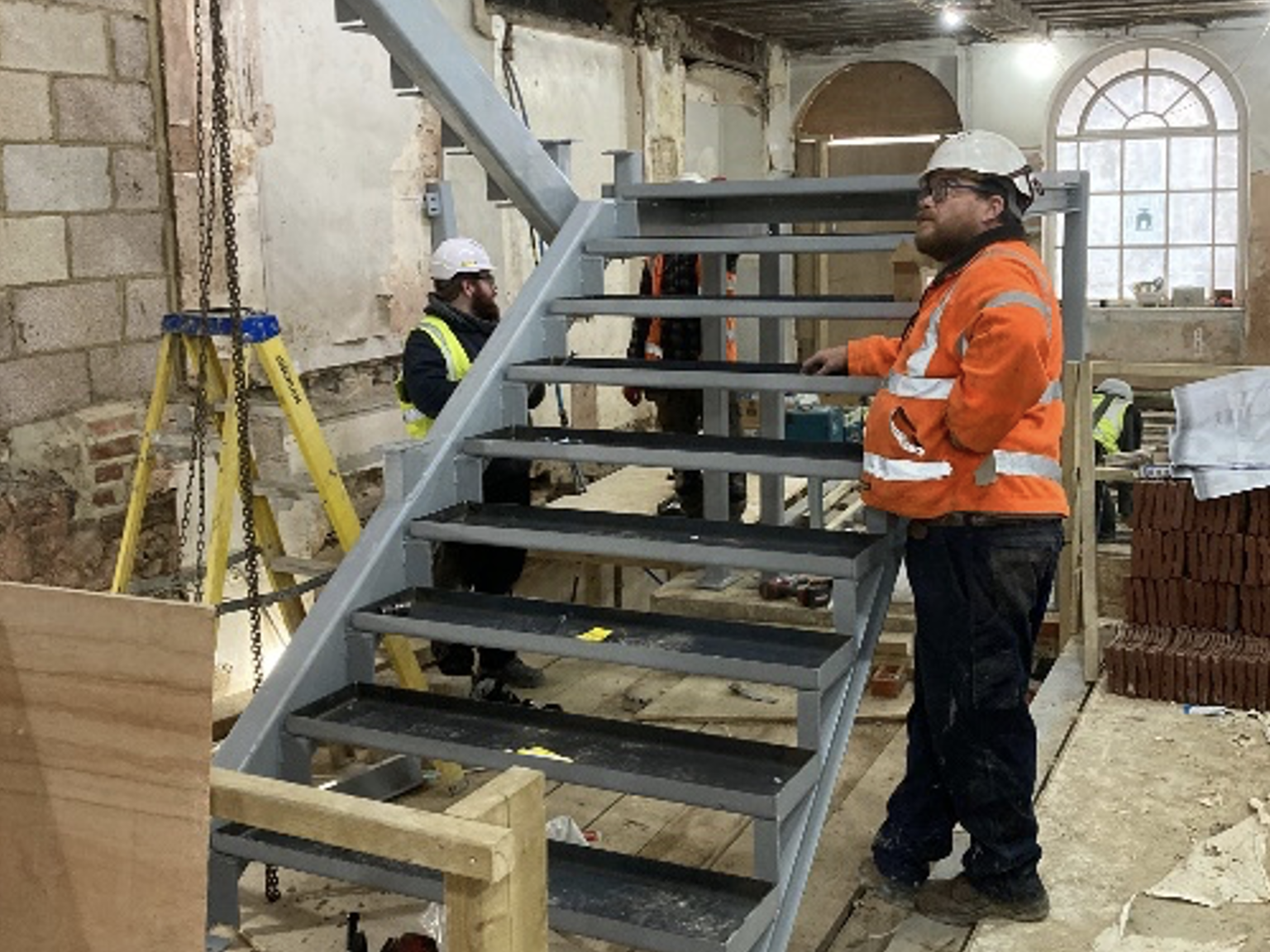

- Completed internal stairs to all floors
- Repaired & repointed Range A stonework

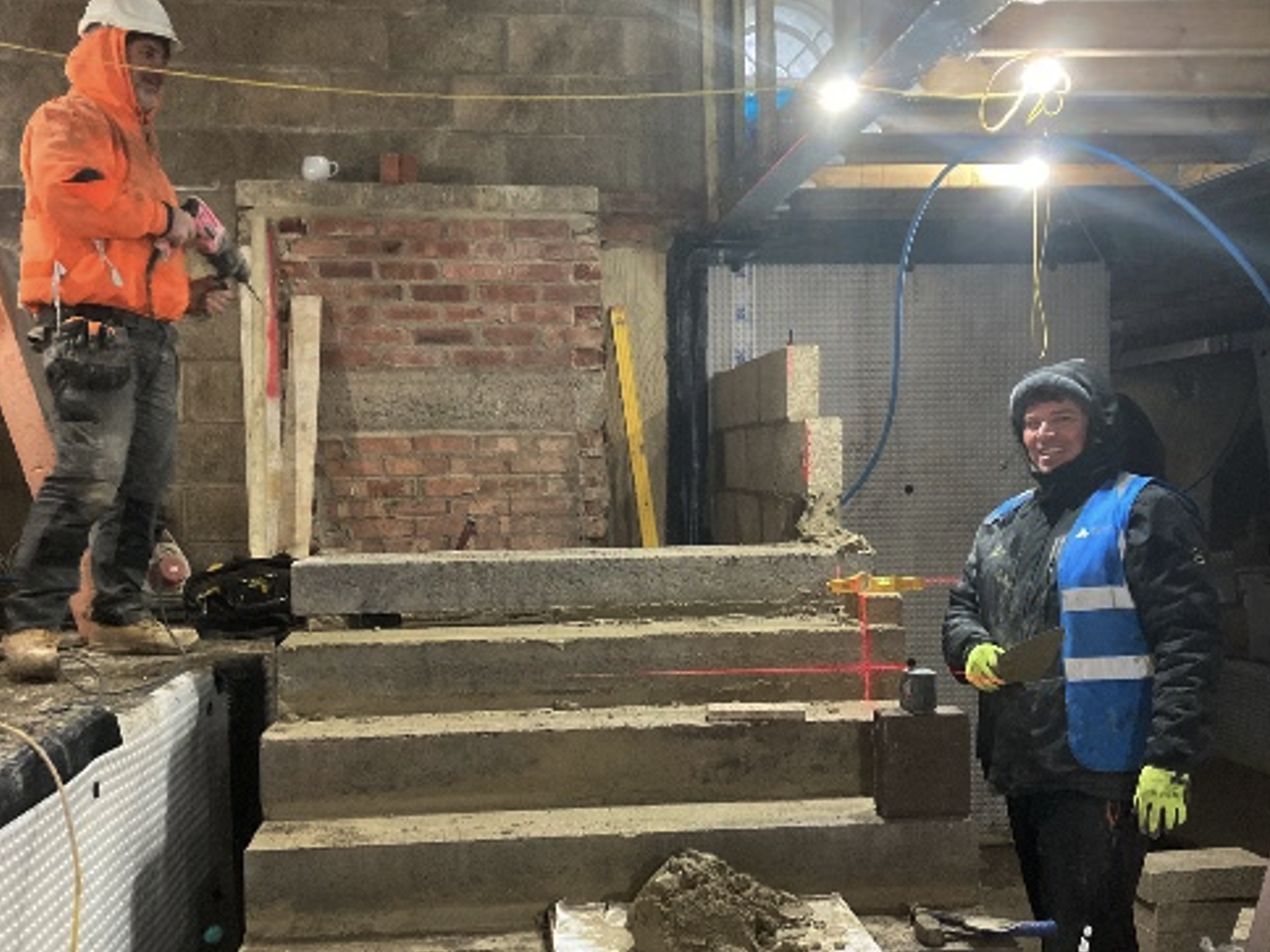

- Screeding of floors in Basement

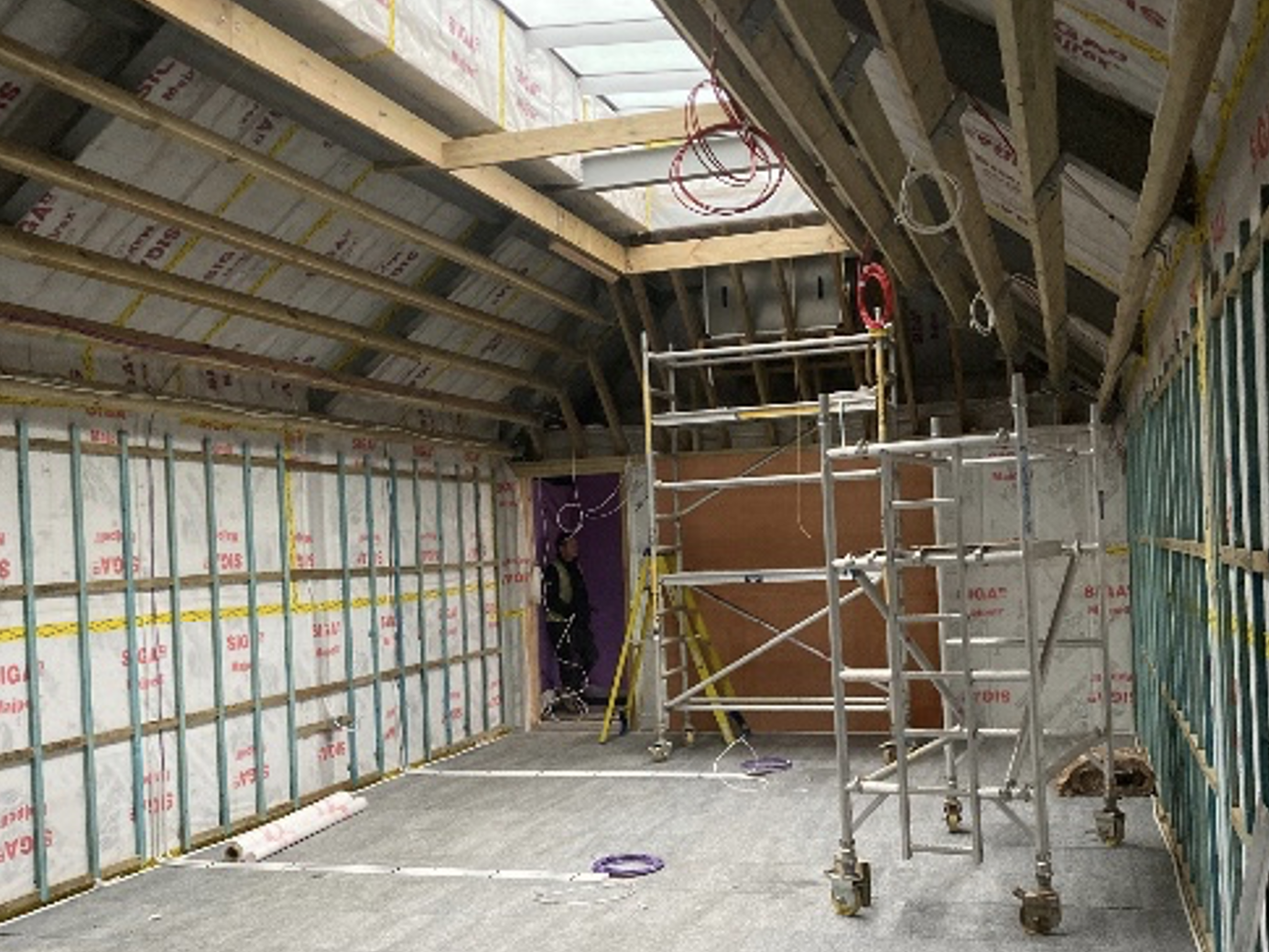

- Continued fitting-out phase & ‘first fix’
- Removed all remaining scaffolding at rear of building





November

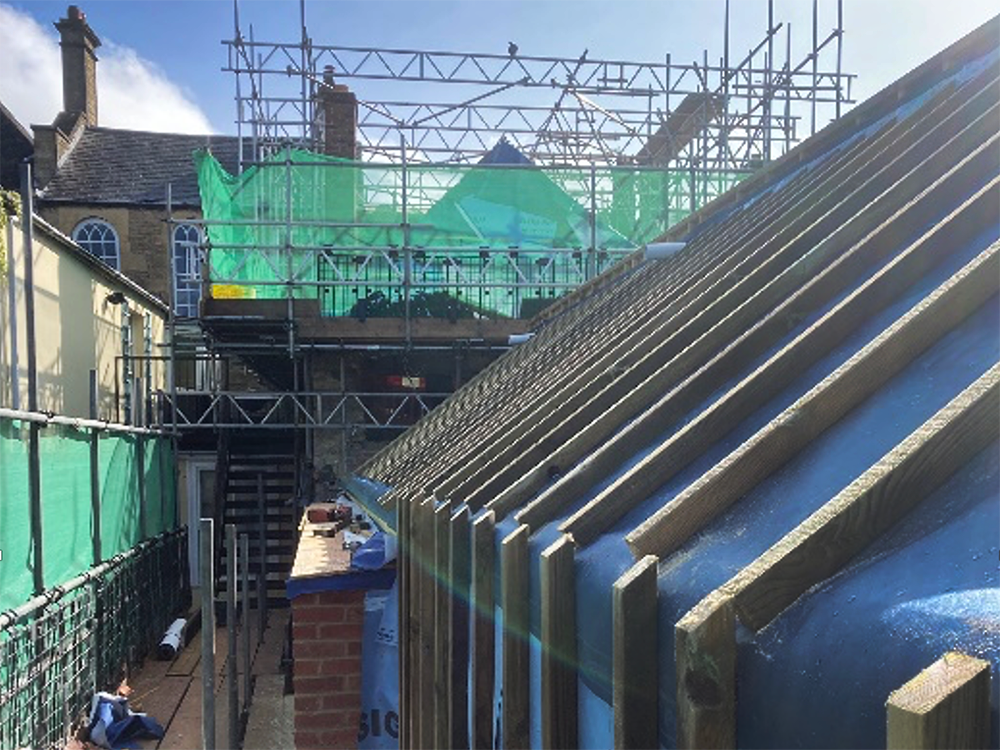

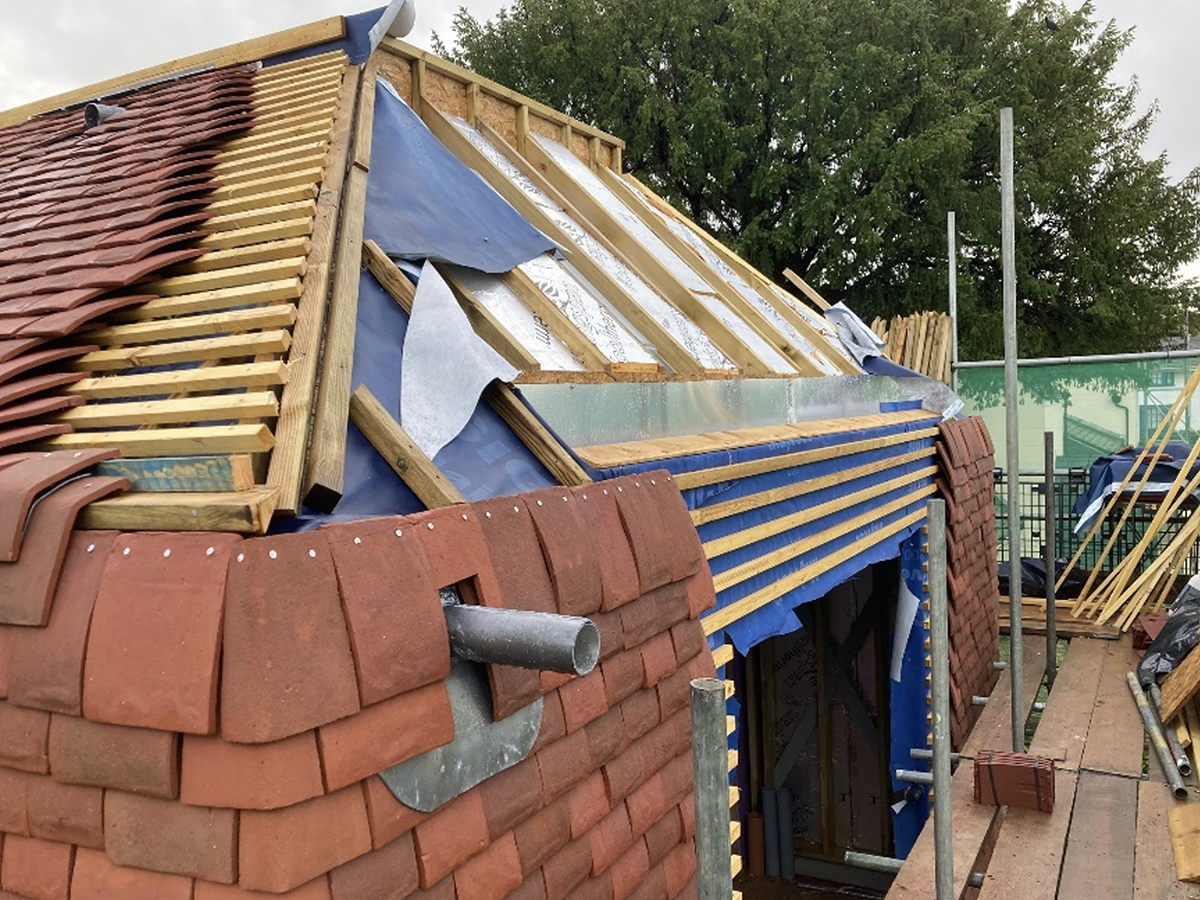

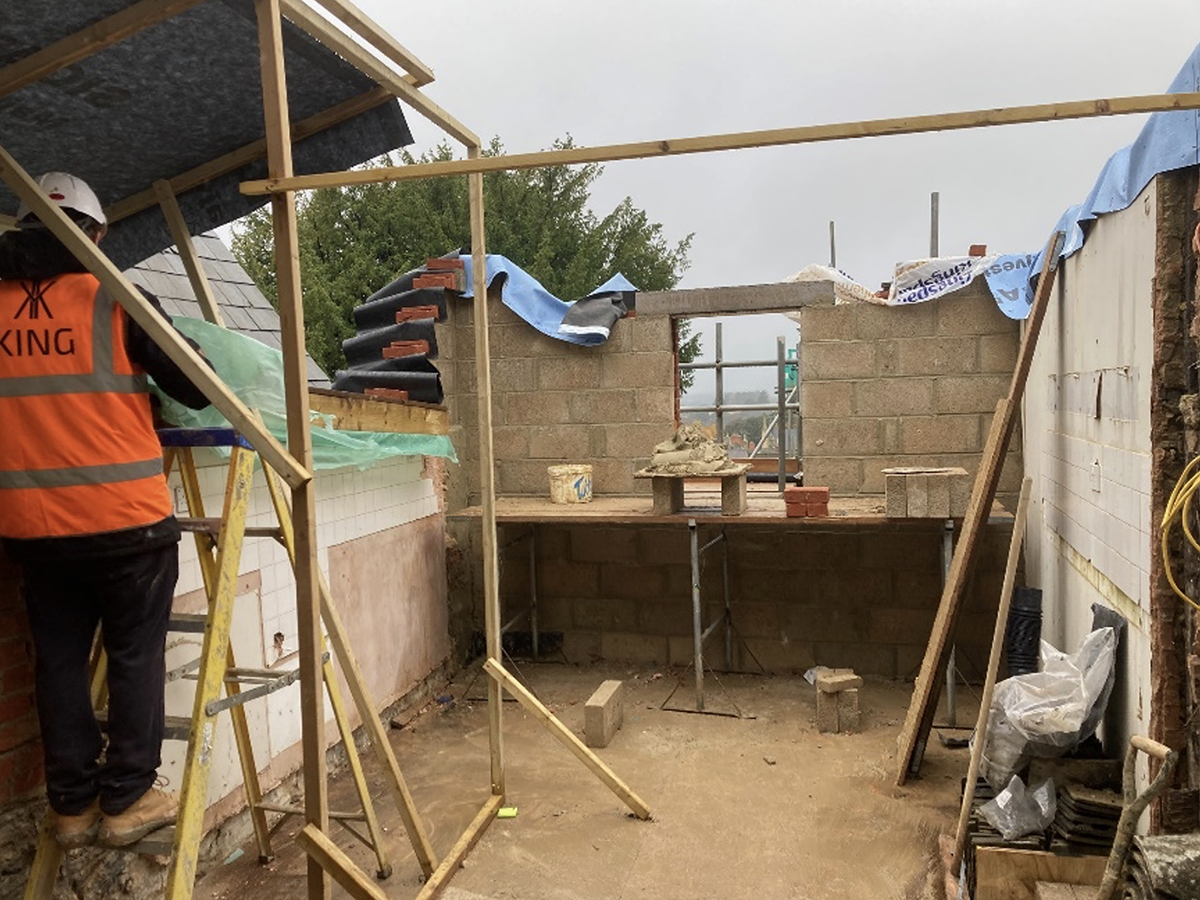

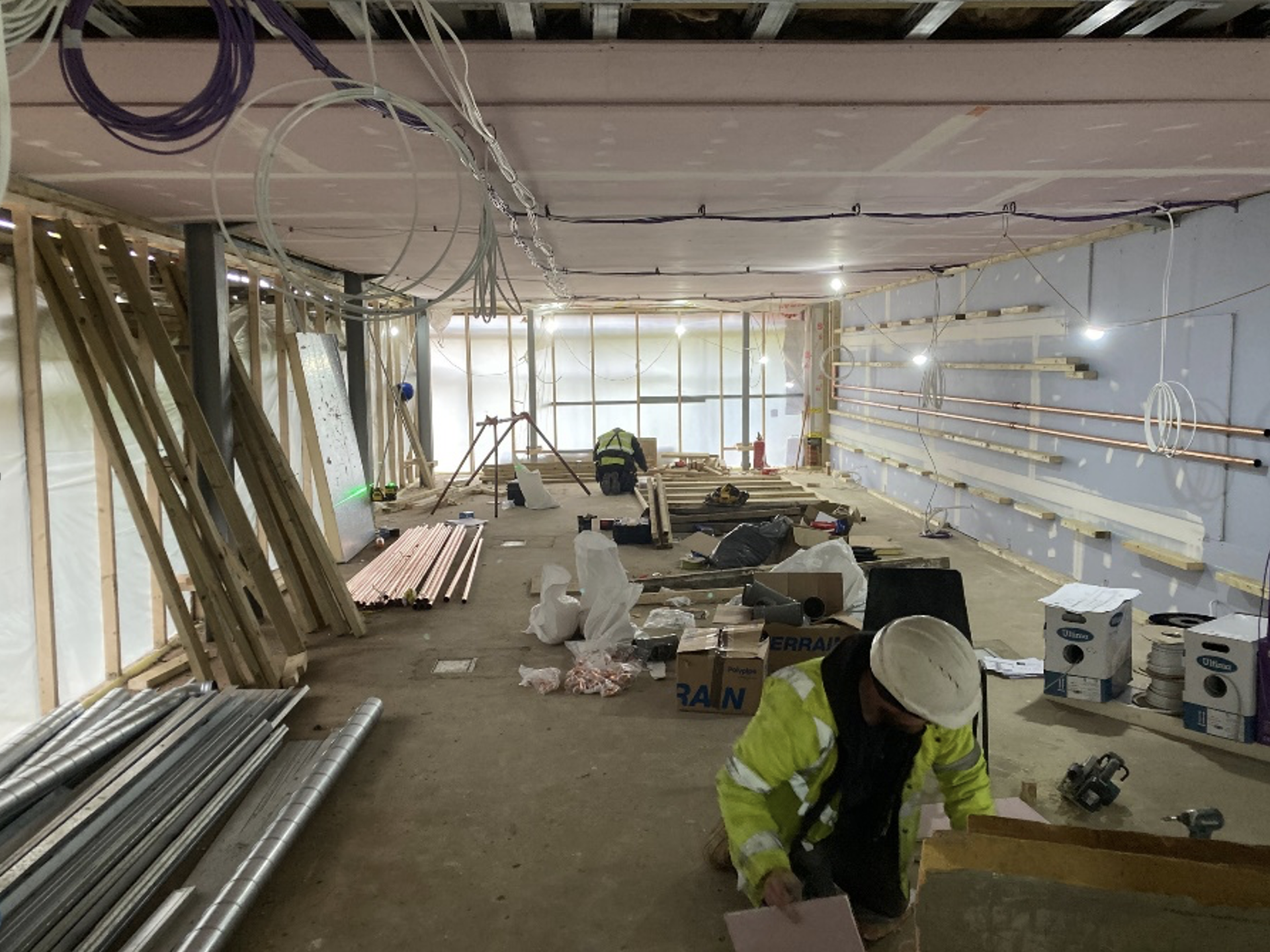

- Completed tiling roof of Community Hall
- Replaced floor in ground floor of Main Range
- Modified scaffolding at rear of building
- Completed masonry, structural steelwork & floor structure works in Range B

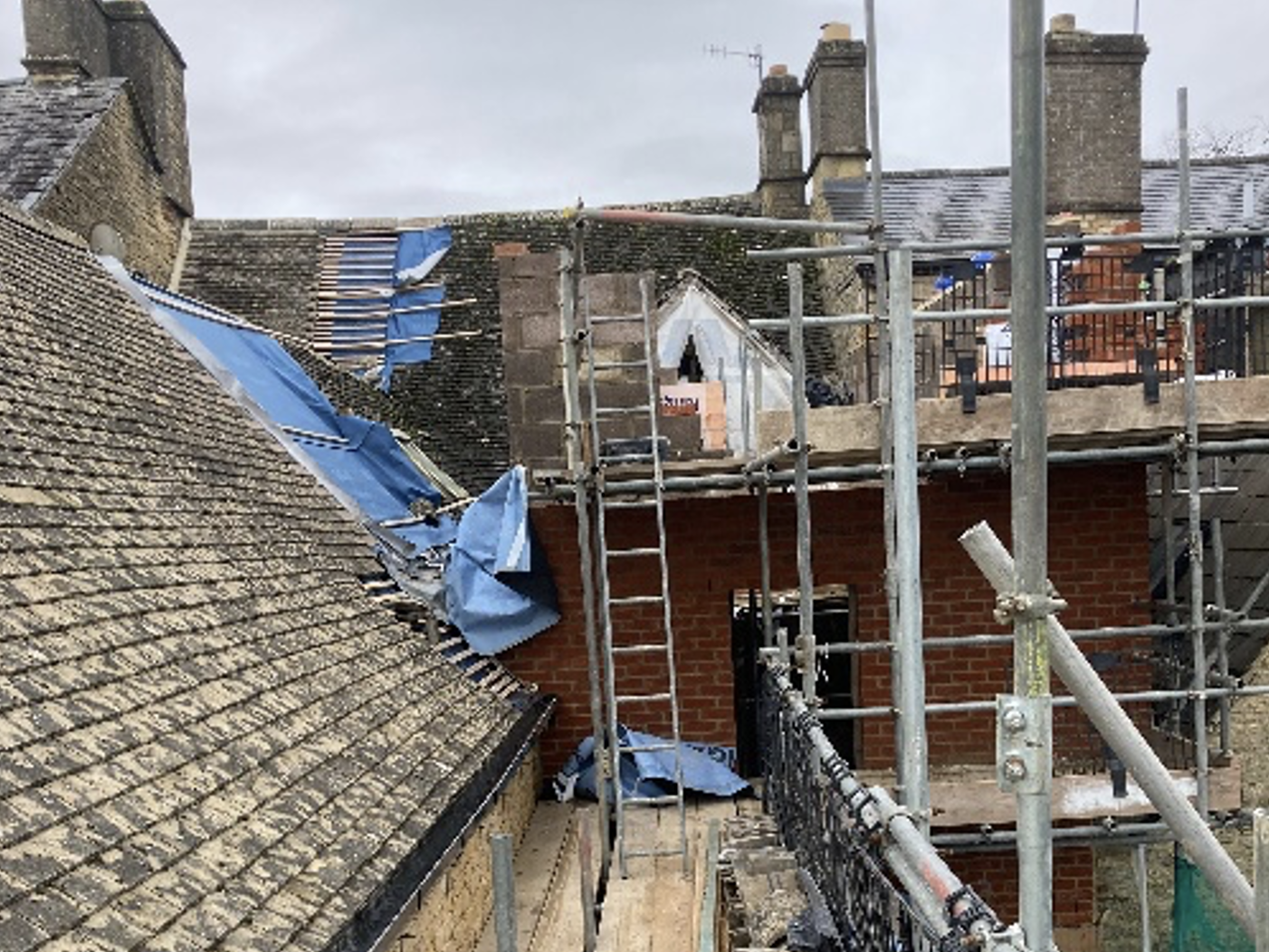

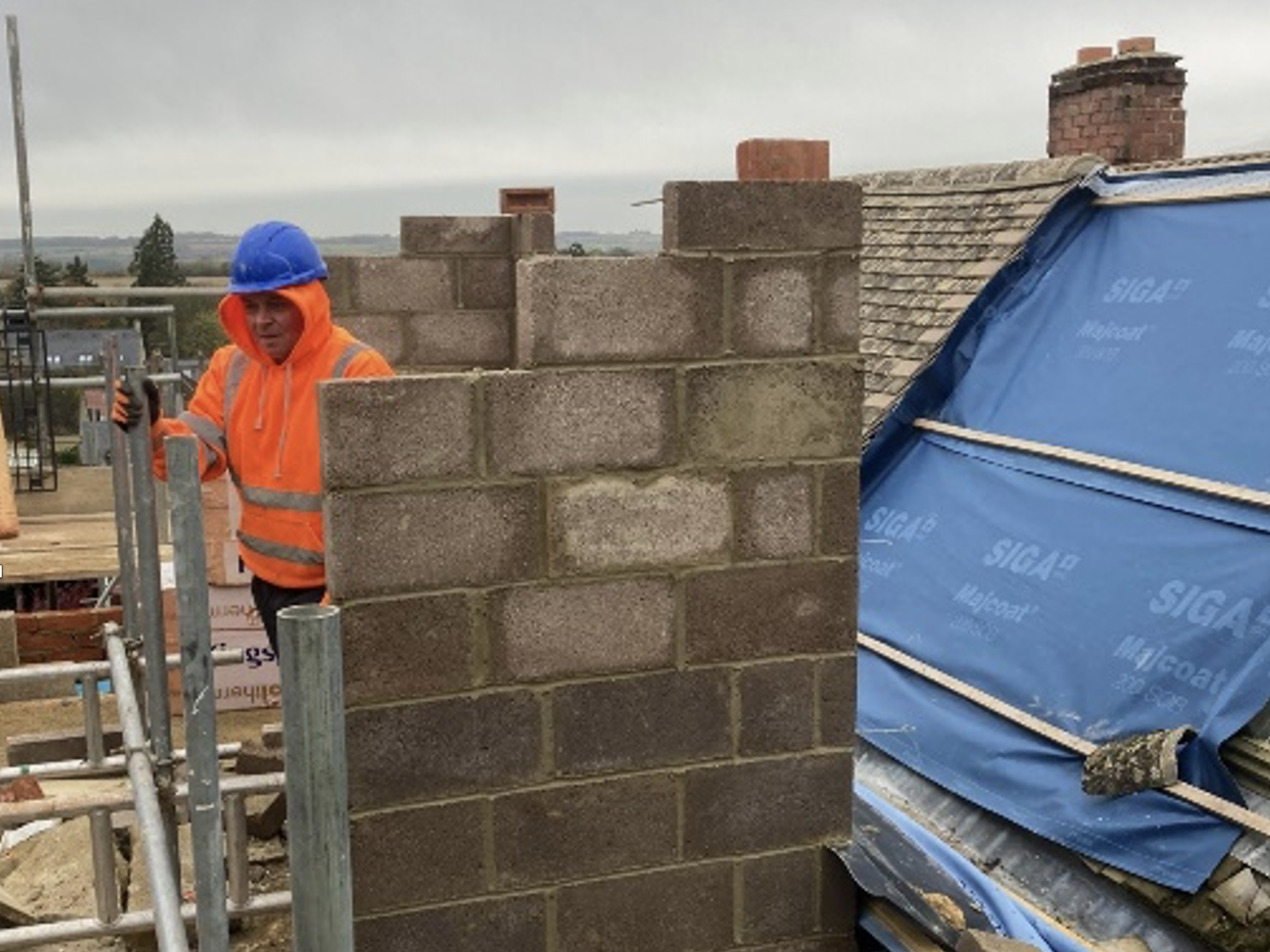

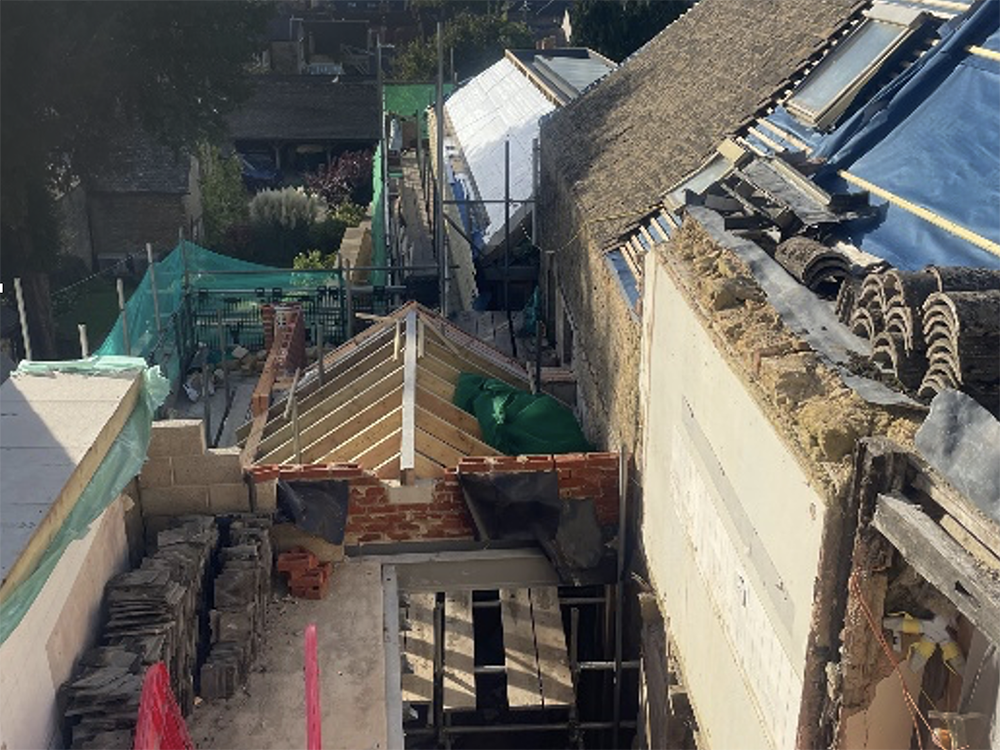

- Continued roof repairs to Range A

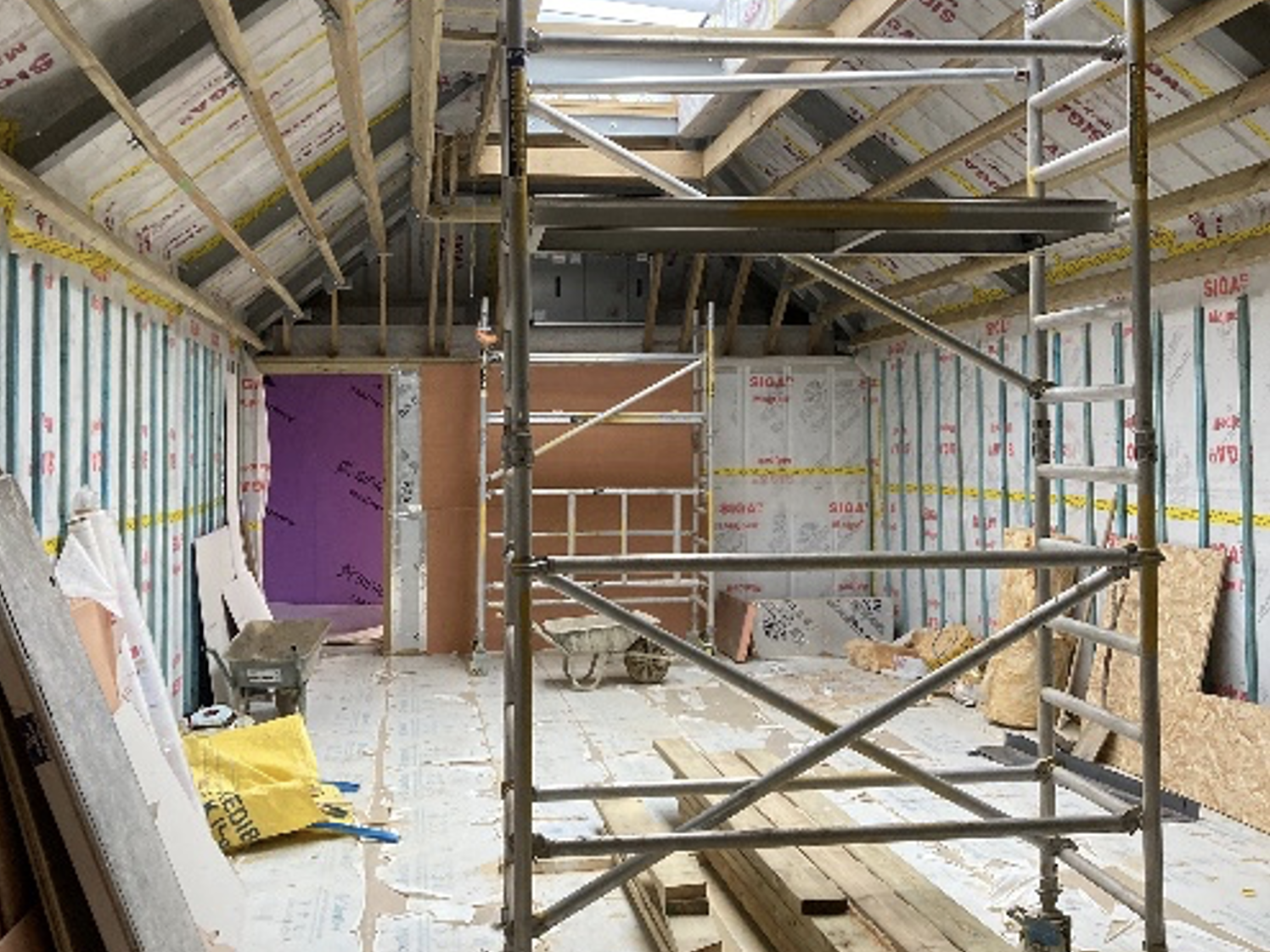

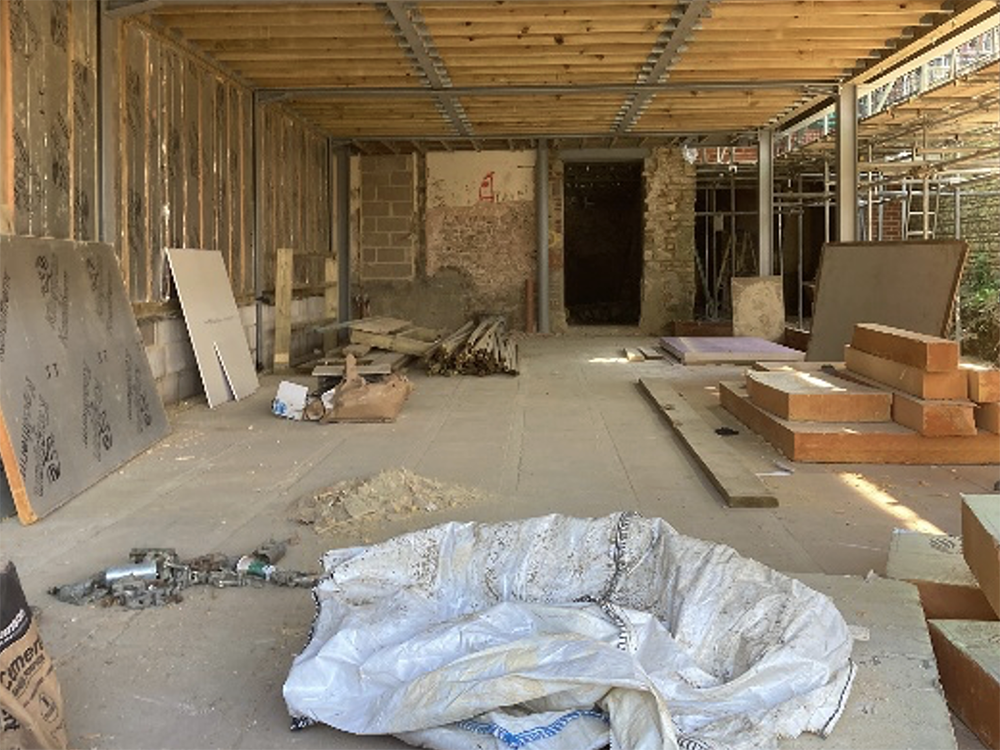

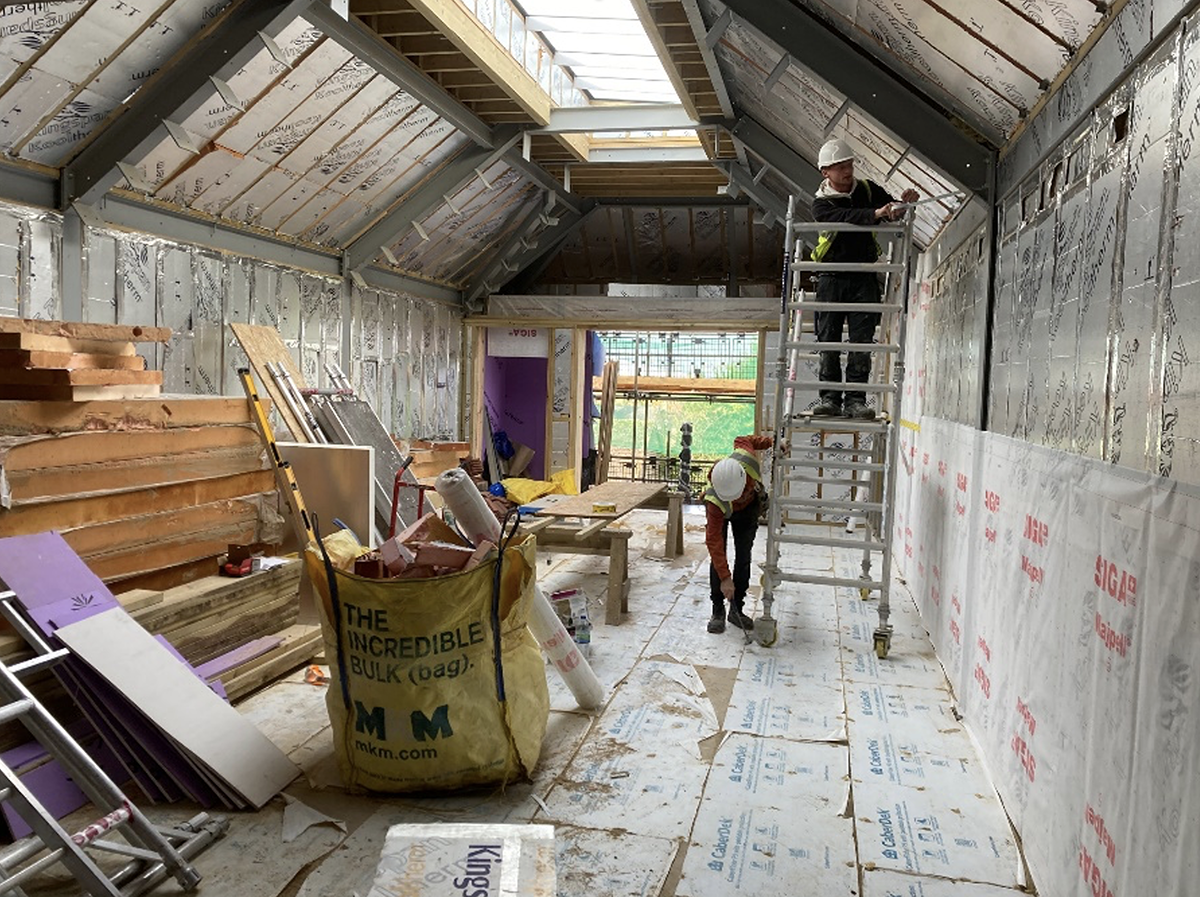

- Started fit-out phase & ‘first fix’
- Started installation of internal stairs





October

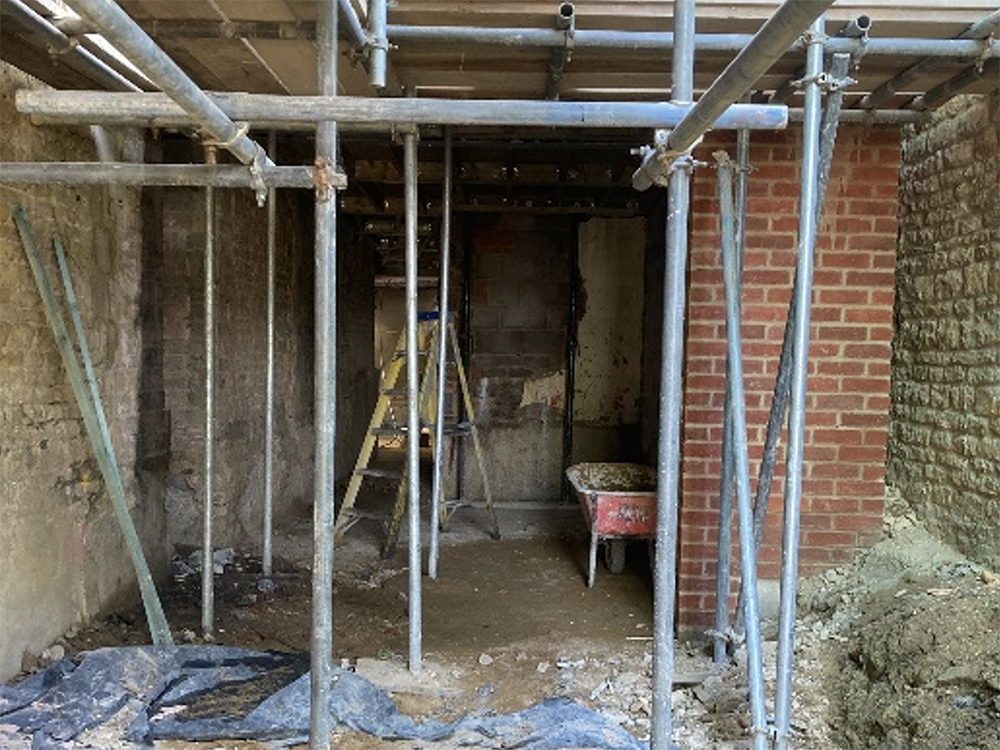

- Removed rear cantilever & front scaffolding
- Continued masonry, structural steelwork & floor structure works in Range B

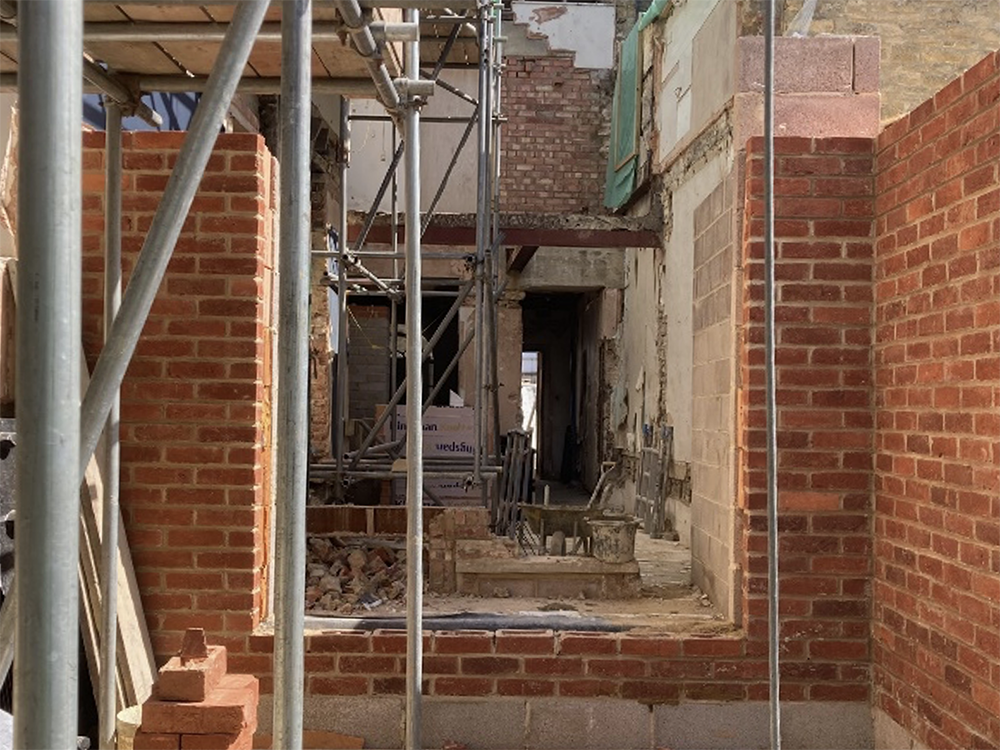

- Formed openings between old & new ranges
- Rebuilt stone gable-end wall of Range A

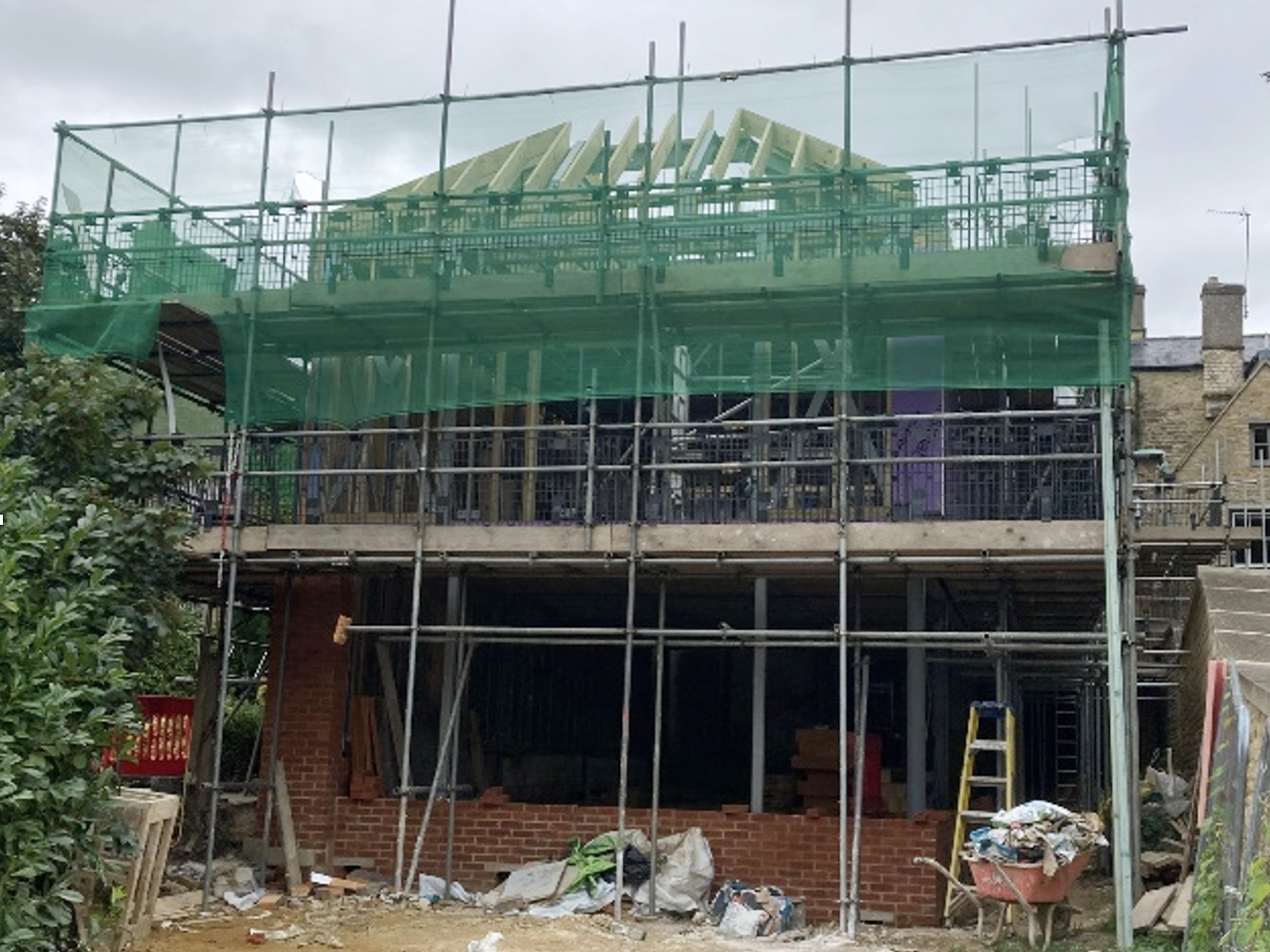

- Tiled walls and north roof of Community Hall
- Installed insulation, underfloor heating & screed floor in Community Hall building


September

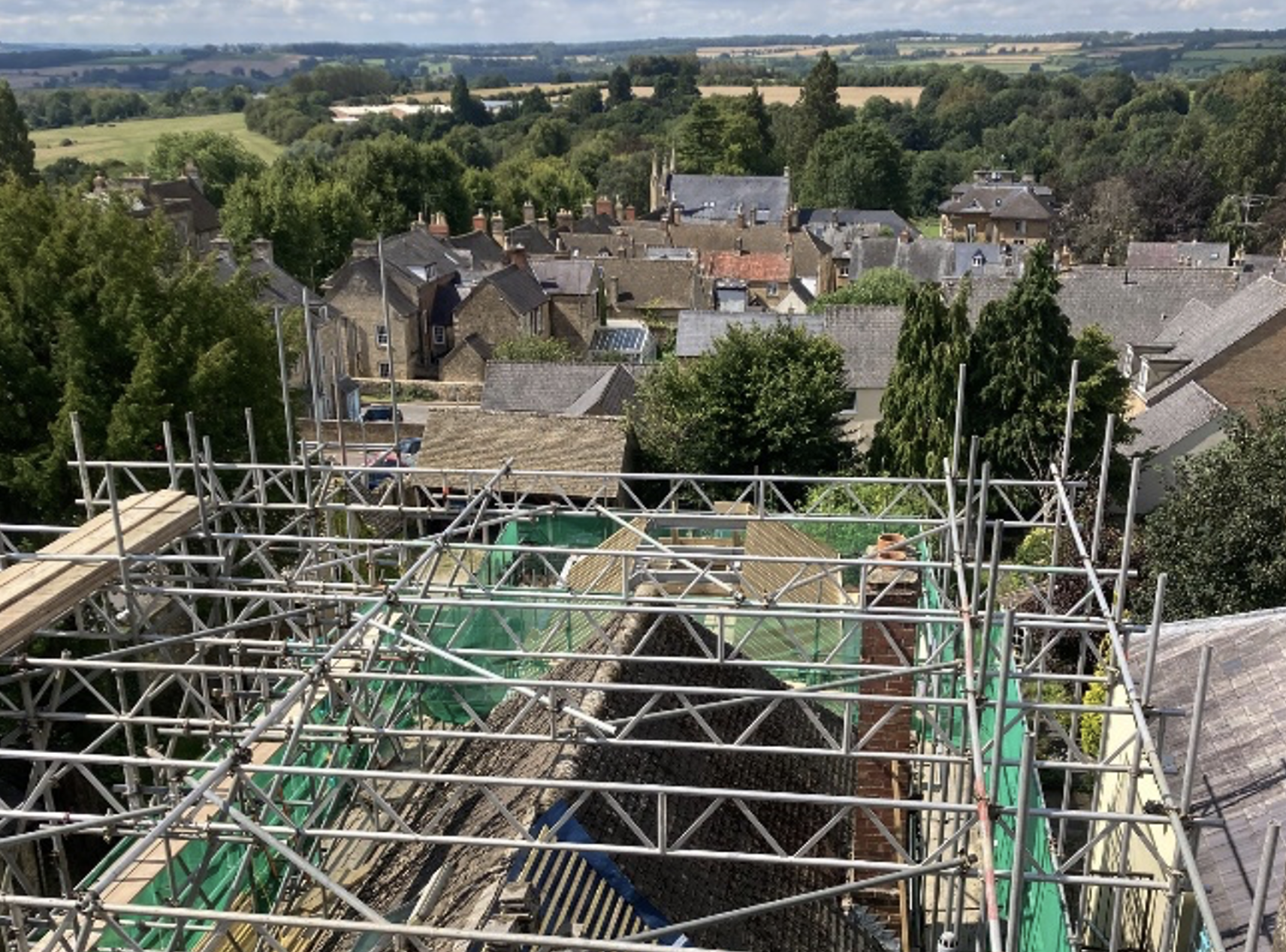

- Continued roof repairs to Ranges A & Main
- Forming new openings between original building and Community Hall
- Felting and battening Community Hall roof
- Installing wall and floor insulation in Hall
- Continued masonry, structured steelwork & floor structure works in Range B
- Clean front façade
of building




August

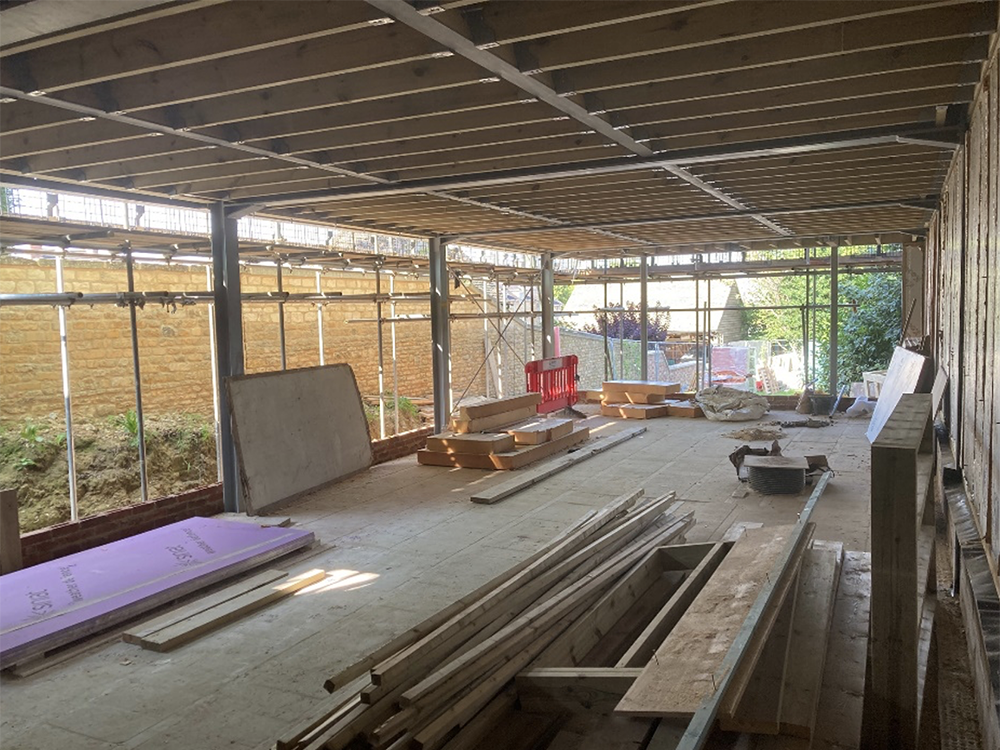

- Masonry, structural steelwork & floor structure in Ranges B & D continued
- Adjusted the rear scaffolding arrangement
- Installed joists, brick/block walls, studwork & roofing timbers in the new Community Hall
- Installed structural steels & ground floor flooring in Range A
- Roofing repair works on Range A continued





July
- Completed substructure & groundworks
- Installed steel frame for Community Hall
- ‘Beam & Block’ floor of Community Hall built
- Masonry, structural steel & floor structure work in Ranges B & D continued
- Started roofing works – scaffolding, repairing Main Range chimneys & Range A roof
- Rebuilt garden walls on south boundary




May/June
- 38 x pile caps excavated and broken-down

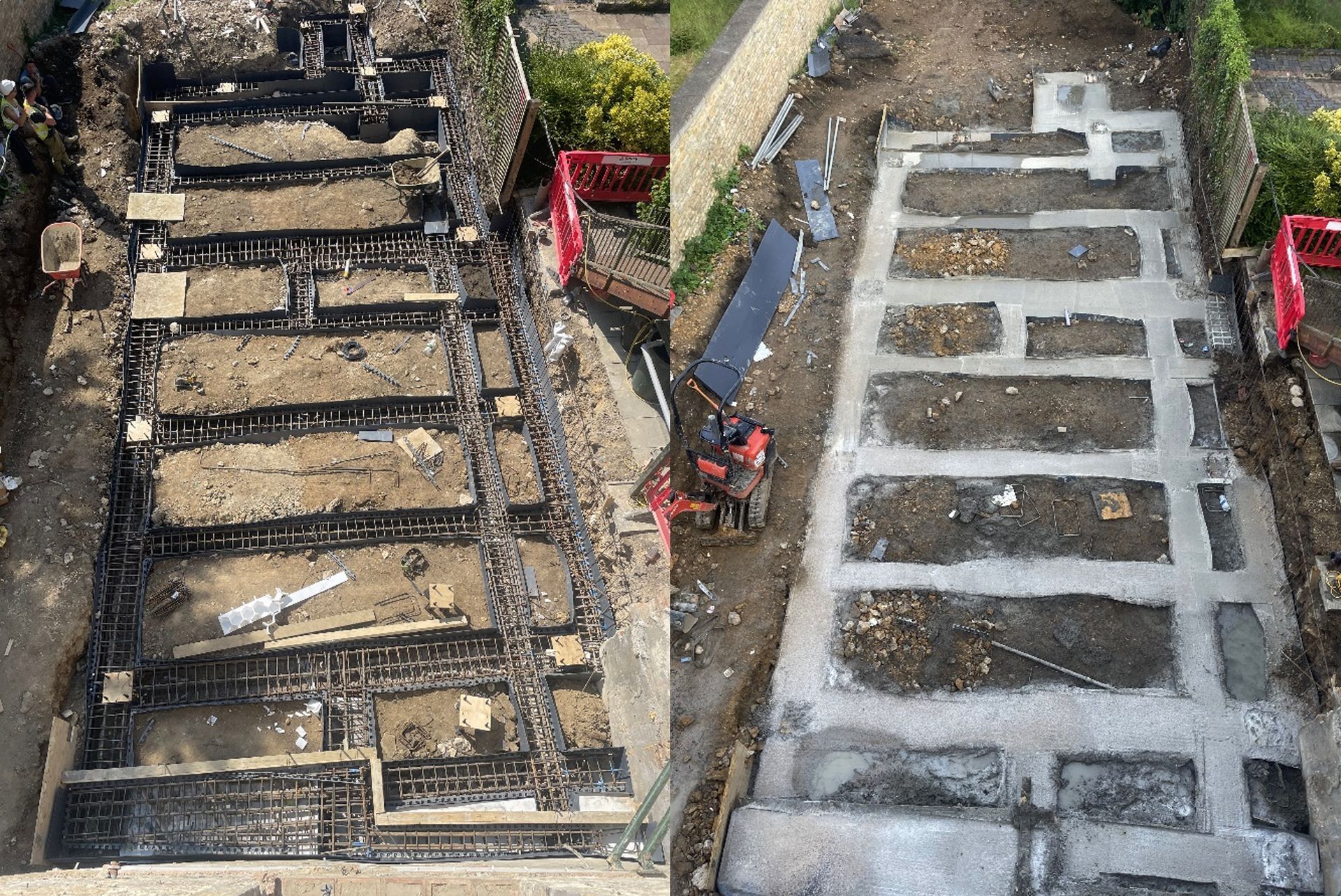

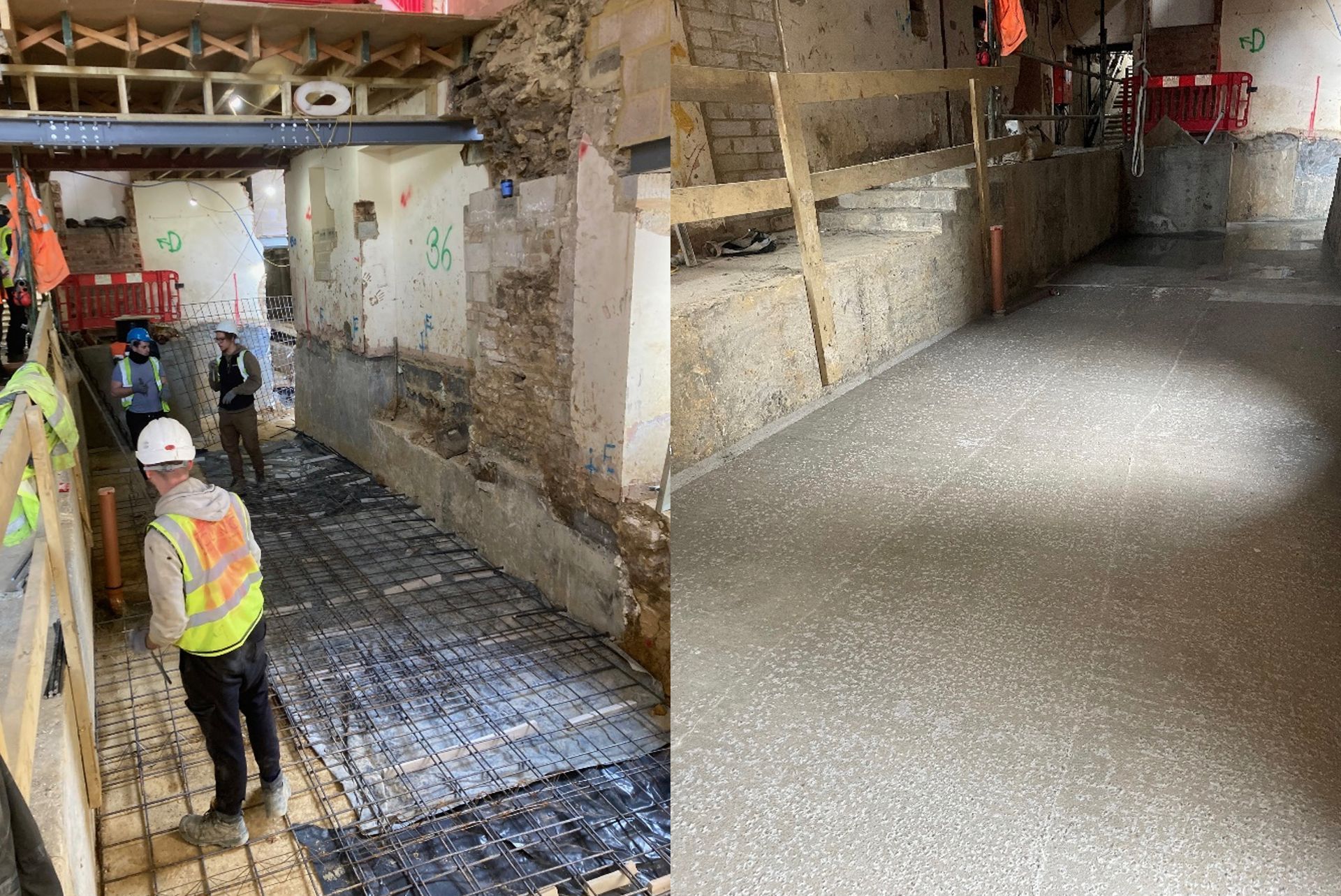

- Community Hall ground-beams excavated, shuttered, reinforced & concreted
- Storm-water attenuation tank built in garden
- Range A ground floor structure removed
- Basement reinforcement & slabs completed
- New masonry in Ranges B & D being built
- Old bank vault door & 2 x safes removed


April
- Removed high-level chimney breast

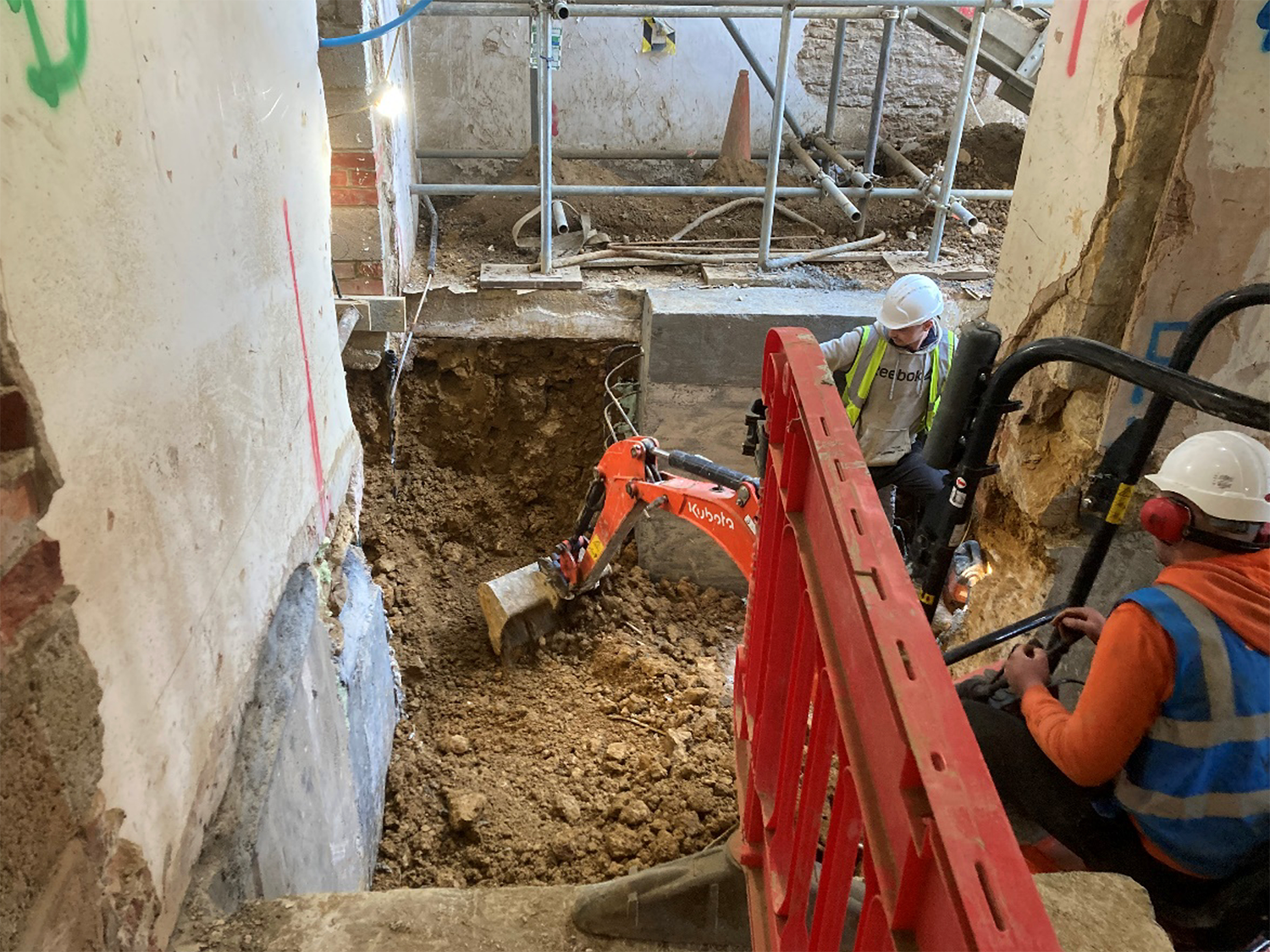

- Completed underpinning external walls
- Completed additional injection grouting & underpinning to strengthen Basement
- Completed retaining walls in Basement

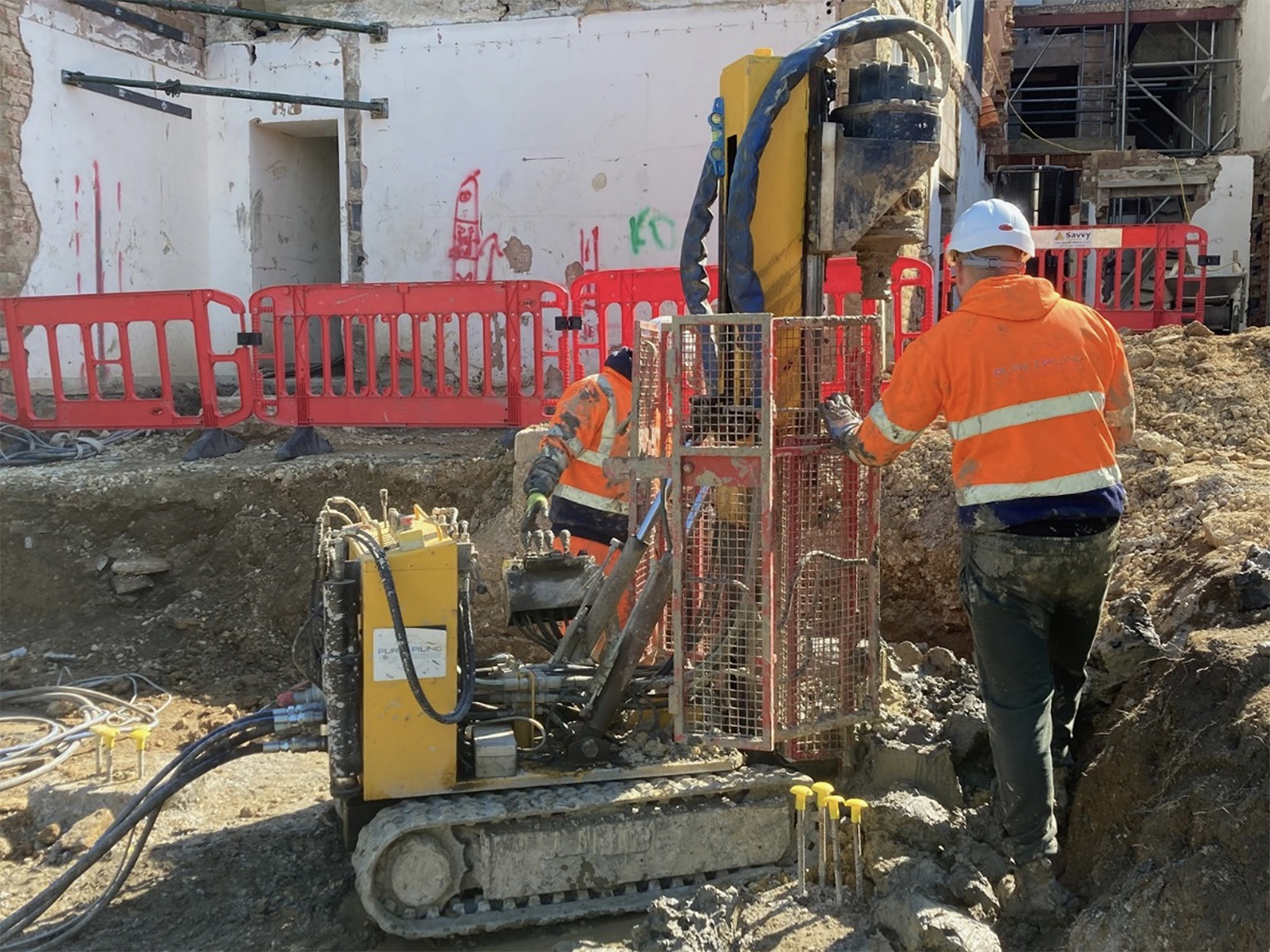

- Installed 38 piles for Community Hall
- Installed new drainage runs


Nov 2022 to March
- Builders’ compound erected
- Site welfare & office established
- Works started 28th November 2022
- Built access ramp to Basement
- Bank vault demolished
- Temporary steelwork installed
- Demolition scaffolding built at rear
- Injection grouting to stabilise ground

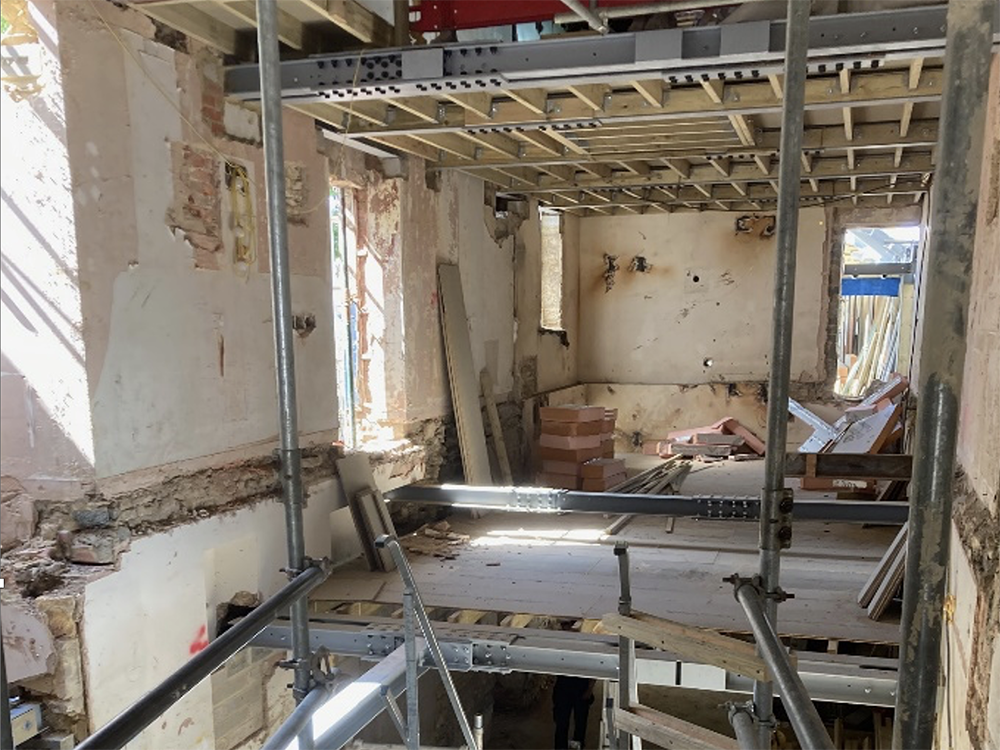

- Internal demolition work completed
- Demolition of rear extensions
- Demolition scaffolding removed
- First Floor steels & joists installed
- Existing staircase removed
- Basement floor slabs removed
- Ground Floor structures removed
- Underpinning of walls started
